Geary/19th Ave Subway and Regional Connections Study Strategic Case

Final Report: July 2026
Stylized illustration of an underground subway tunnel

Executive Summary

ES.1 Introduction

The Geary/19th Ave Subway is envisioned as a rail rapid transit subway oriented under Geary Blvd and 19th Ave in San Francisco. An investment of this scale a dual-track subway approximately 10 miles in length, with approximately 56 stations is significant, with a capital cost estimated in the range of $20B$30B. However, the potential benefits to San Francisco, the region, and the statewide rail network are transformative. This study, the Geary/19th Ave Subway and Regional Connections Study Strategic Case, aims to advance the understanding of key project development components and choices, including the anticipated benefits that the subway could deliver.

The idea for a subway under Geary Boulevard has been included in numerous studies over the past decades. Recent planning and community engagement work, documented in the Connect SF Transit Strategy (2021) and the 2050 San Francisco Transportation Plan (2022) evolved the understanding of potential needs and opportunities in both the Geary Blvd corridor and western San Francisco, resulting in a corridor that begins in Downtown San Francisco, continues west along Geary Blvd as far west as the Inner Richmond, where it turns south below Golden Gate Park and continues beneath 19th Ave through the Sunset District, terminating roughly near the existing Daly City Bay Area Rapid Transit (BART) station.

This study uses evidence and analysis to address four key questions:

  • What is the broad case for advancing the Geary/19th Ave Subway to the next phase of study?
  • What are the potential benefits unlocked by an investment in a Geary/19th Ave Subway?
  • What are the key decisions that will shape those benefits, such as the project’s route, technology, and other design options?
  • What are the key issues that should be incorporated into the next phase of study?

These questions enable decision-makers, project partners, and the public to understand the benefits that would be unlocked by the Geary/19th Ave Subway and to guide future phases of project development.

Importantly, this study did not:

  • Select a preferred alternative or advance planning/design beyond a pre-feasibility level
  • Confirm benefits, costs, risks, and timelines for a specific alternative

These decisions will be advanced in future phases of project development, informed by additional analysis and stakeholder engagement, should the project proceed.

ES.2 Project Needs and Goals

The Geary/19th Ave Corridor is critically important for moving people and goods across San Francisco and the wider Bay Area. A Geary/19th Subway provides the opportunity for a high capacity, fast, frequent, and reliable transit service across the corridor and beyond. It can help meet future travel demand, support planned housing development, and better meet the evolving needs of San Francisco and the Bay Area.

Today, the Geary/19th Ave Corridor is home to nearly 29% of San Francisco’s population, 43% of its jobs, and many significant employment, cultural, academic, and social service centers and institutions. Communities along the corridor are anticipated to grow significantly in the coming decades. Population growth planned for in San Francisco’s 2022 Housing Element reflects 100,000 new people and 80,000 new jobs along the corridor.

Travel demand on the corridor is significant. Each day hundreds of thousands of trips are made to places along the corridor or to access other parts of the Bay Area. This high level of travel demand can make transit crowded and roads congested, resulting in slow and unreliable travel times.

Recently, substantial transit priority investments along Geary Boulevard and 19th Avenue have improved reliability along the congested surface network. However, they do not always provide competitive travel times for trips across the entire city or to key regional destinations elsewhere in the Bay Area, nor do they provide the capacity needed to serve future demand. The improvements required to meet these needs are not achievable solely with at-grade transit service. A new grade-separated rapid transit service a subway is needed to provide reliable, fast, frequent, and comfortable mobility and to support the growth expected along the Geary/19th Ave Corridor.

To support the analysis and development of a Geary/19th Ave Subway, the study team identified three overarching goals for the Geary/19th Ave Subway:

  • Icon of a bus.

    Improve the traveler experience and provide better transit service to the corridor, San Francisco, and the Bay Area

  • Icon of a person walking and a person using a wheelchair.

    Serve current needs and planned growth in the corridor and region

  • Icon of a park bench next to a tree.

    Support crucial regional policy goals of affordability, equity, and the environment

ES.3 Subway Design Options

The study team identified major design choices for the subway and how each could result in potential tradeoffs that will need to be addressed or resolved in subsequent project phases. The study team identified three key topics of consideration to inform the potential universe of alternatives for a Geary/19th Ave Subway:

  • What are the key destinations that a Geary/19th Ave Subway should serve?
  • How should a Geary/19th Ave Subway connect to or integrate with the existing and planned regional rail network?
  • What rail technologies are well suited for the operational and service requirements of the Geary/19th Ave Subway?

This phase of work has examined an initial range of routing and station location considerations across the corridor, as well as in three focused areas within the corridor:

  • Downtown San Francisco;
  • The connection between Geary Blvd and 19th Ave portions of the corridor; and
  • The southern terminus of the project in northern San Mateo County.

ES.4 Potential Benefits of a Geary/19th Ave Subway

The study team evaluated the performance of the Geary/19th Ave Subway, and the project’s potential design options and choices, against a set of metrics developed to illustrate how and to what extent the project would address the project goals.

Key project benefits, and illustrative results, are summarized below:

  • icon of a bus

    Grow transit ridership in SF and across the region: Serve 162,000 to 314,000 trips a day, including 62,000 to 106,000 net new transit trips.

  • icon of a clock

    Improve customer experience and travel times: Save transit riders from 19,000 to 45,000 hours per day (or roughly 57 minutes per passenger, per trip) and reduce regional crowding by 15 to 30%.

  • icon of a house and skyscrapers

    Increase access between jobs and workers: The average San Francisco worker could access up to 47,000 more jobs in 45 minutes by transit, while the average Bay Area worker could access up to 10,000 more jobs in 45 minutes.

  • Icon of arroes pointing in different directions

    Increase regional accessibility: Put 138,000 to 156,000 more households and 382,000 to 404,000 more jobs within walking distance of transit.

  • Icon of a house with a dollar sign inside it

    Support housing affordability: 41,000 to 50,000 new housing units would be in walking distance of rail rapid transit.

  • Icon of a cloud of exhaust coming from a car's tailpipe

    Reduce localized air pollution and single-occupancy vehicle travel: Reduce vehicle miles traveled in San Francisco by 47%, corresponding to greenhouse gas emissions reductions of by 23,000 to over 35,000 tons per year.

  • Icon of three people of differing heights standing on platforms that raise them each up to the same height

    Deliver disproportionate benefits to residents of Equity Priority Communities (EPCs): For example, access to jobs within 45 minutes on transit for the average resident of an EPC would increase 60% more than the average of all San Francisco residents (76,000 jobs vs 47,000 jobs).

ES.5 Key Project Building Blocks

ES.5.1 Project Funding

An urban rail transit project such as the Geary/19th Ave Subway is a large, complex public investment. Existing local, regional, state, and federal funding sources are not sufficient to fully fund the project, which has an initial cost estimate range of approximately $20B$30B in 2026 dollars, as discussed in Chapter 4. The project has the potential to drive significant value creation in multiple areas (such as travel time, land value, economic development, and environmental quality). The study team identified potential mechanisms to return a part of this value to the project, helping to support its funding plan. It is important to begin exploring these mechanisms in parallel with early planning, to inform further development of the funding strategy and advancement of specific funding sources during future phases of work.

Subsequent phases of work should include the development of an indicative funding plan for the project, reflecting the ranges of potential funding from existing and new sources. This plan should include initial revenue range analyses for a range of potential new sources, developed to an order-of-magnitude level, with a focus on the sources that could harness the value created by the project. Development of this indicative funding plan will also require coordination with other related efforts, such as pricing studies, travel demand management initiatives, and regional and statewide rail planning and development efforts. Future phases of study will also seek and include input on potential funding strategies from members of the public and policy-makers.

ES.5.2 Engagement & Outreach

In addition to technical work, engagement with residents, businesses, institutions, and community stakeholders is essential to advancing project development for the Geary/19th Ave Subway. This study included public outreach activities, to identify key interests and potential concerns of community members, and to share study analysis and initial findings. Future phases will also include public engagement efforts, as specifics about the subway and its design, construction, and operation come into better focus.

ES.5.3 Project Development & Prioritization

The Geary/19th Ave Subway is one of five major rail and transit enhancements identified in the ConnectSF Transit Strategy and the 2050 San Francisco Transportation Plan (SFTP). Each project will require substantial funding to advance from concept to final construction and delivery. While these plans laid out the initial concepts of each project, they did not prioritize the order in which each should advance or be implemented.

Project prioritization is anticipated to begin with the preparation of the next major update to the SFTP SFTP 2060, which is planned to kick off in 2027. This plan will use updated information about each project’s performance, as well as other effectiveness and readiness criteria, to make recommendations regarding how and on what timeline San Francisco’s full vision of long-range transit and rail expansion should advance. Through the SFTP process, projects will be evaluated based on their impact with respect to the SFTP goals: equity, economic vitality, environmental sustainability, safety & livability, and accountability & engagement.

ES.6 Conclusions & Next Steps

ES.6.1 Conclusions

This study finds that a grade separated, high capacity rapid transit investment is both needed and viable in the Geary Boulevard and 19th Avenue corridors in Western San Francisco. As future phases of the project are completed, significant project decisions will need to be considered related to regional integration, routing and station location, technology, and funding, in increasing levels of detail. Future phases will also more deeply explore the trade-offs among these decisions, informed by more robust engineering, planning, and cost estimation than was completed in this initial phase of work.

In summary, this study finds that:

  • The case for the Geary/19th Ave Subway is promising: The Geary/19th Ave Subway is an integral part of the future San Francisco, Bay Area, and statewide rail system, and San Francisco should continue to advance planning and project development. The project will create value in time savings for travelers, accessibility and value of land, and economic activity and productivity; leveraging this value will be key to the project’s viability and success.
  • Regional connectivity expands and broadens benefits: The Geary/19th Ave Subway performs well as a San Francisco-only investment, but performs much better as an integrated part of the region’s rail network. By enabling through-running of trains beyond San Francisco, project benefits would also accrue to a wider range of Bay Area residents, workers, visitors, and travelers.
  • Multiple design options can provide improvements: Choices about how to route the project at both ends of the alignment and for the connection between Geary Blvd and 19th Ave should be informed by additional technical work and robust engagement with stakeholders. While project performance of the various options for these segments of the project is similar, the profile of project benefits may vary depending on the final routing and station location decisions made in future phases.
  • The Geary/19th Ave Subway delivers travel time savings, environmental improvements, and equity benefits: In future years, the project drives improvements in many key metrics related to travel time, environmental quality, and equity as compared to a future where the project is not built.
  • Project development and delivery will require significant new funding sources: While the project is expected to perform well under traditional federal and state funding criteria, major transit investments such as the Geary/19th Ave Subway must secure support from all levels, including the development of new, project-specific funding sources.
  • A Geary/19th Ave Subway will drive value creation: Investing in the Geary/19th Ave Subway will create value in terms of land use, economic activity, mobility improvements and time savings, and reduced climate impacts. Capturing a share of this value will be a critical element of the project’s funding plan, and will help to secure other regional and state funds.

ES.6.2 Next Steps

The Geary/19th Ave Subway and Regional Connections Study is the initial step of a multi-year process by which a major transit capital investment is planned, environmentally cleared, designed, constructed, and eventually opened for passenger service. Projects proceed through multiple stages of development, with the conclusion of each supporting decision-making regarding the project’s readiness and worthiness to advance to subsequent stages.

Because major transit capital projects are complex undertakings involving many stakeholders, varied interests, and multiple approvals, it usually takes at least 15 to 20 years to progress from project initiation to revenue service. Peer projects in California have typically spent a total of approximately 58 years in the Planning, Alternatives Analysis, and Environmental stages, followed by approximately 710 years for construction and commissioning. Projects moving more quickly through these steps typically demonstrate robust local and regional financial commitment, including through voter-approved funding measures, that enable project sponsors to secure necessary approvals and commitment of state and federal funding.

The completion of Concept Development and Alternatives Analyses studies for the Geary/19th Avenue Subway are estimated to require approximately $10 million to $15 million, depending on the number of alternatives explored and level of engineering design required. The study team has identified an initial set of prioritized Alternatives Analysis tasks that could be advanced with available funding approximately $1.5 million in programmed half-cent sales tax funds, up to $3 million if the project is successful in securing competitive regional funding in the near term. The inclusion of specific tasks within a next phase of work will be subject to available funding, including external grant funding from regional and state sources. An overall aim of the immediate next phase would be to undertake prioritized work that is supportive of subsequent completion of the full Alternatives Analysis stage, including preparation for the future Environmental Review stage.

Introduction and Background

Local and regional planners have considered the potential for a subway along the Geary corridor through numerous studies over the past several decades. These plans have consistently identified the need for an improved connection between the west side of San Francisco and Downtown, and the needs of travelers have remained constant — faster trips, less crowding, and better connections to the regional transit system. Recent investments in the surface transportation network through projects including the San Francisco Municipal Transportation Agency (SFMTA)’s projects that provided substantial bus transit priority and safety treatments along Geary Boulevard and 19th Avenue have helped address nearer-term capacity and congestion challenges, but long-term forecasts still show the need for grade-separated rapid transit in the corridor.

The ConnectSF Transit Strategy (2021) and the 2050 San Francisco Transportation Plan (2022) evolved the understanding of potential solutions. By aligning a subway under Geary Boulevard with a new transbay rail crossing in the east (Link21) and by incorporating an alignment under 19th Avenue towards a connection in San Mateo County to the south, the project would benefit both San Francisco and regional travelers, acting as an important link in the regional and state rail network. These needs and benefits were highlighted most recently in the 2024 update to the California State Rail Plan, which identifies connecting western San Francisco into the statewide rail network as a long-term priority.

The potential benefits of a Geary/19th Ave Subway are transformational for San Francisco, the Bay Area, and the Northern California mega-region. A new subway would give people reliable, fast, and frequent access to places across the Bay Area, while supporting efforts to improve housing affordability, economic activity, sustainability, and equity for disadvantaged communities.

Addressing Transit Operating Shortfalls While Planning for the Long-Term

At the time of this report, the federal, state, and regional pandemic relief funds that have shored up the operating budgets of Bay Area transit agencies, including SFMTA, will be exhausted by June 2026. In early 2026, the California State Transportation Agency and the Metropolitan Transportation Commission approved a loan of state funds to SFMTA, BART, Caltrain, and AC Transit, which will provide bridging operating resources to these agencies starting in Fiscal Year 2026/27. In November 2026, San Francisco voters are anticipated to consider two ballot initiatives, including a five-county regional measure and a local measure, that would provide operating funds for transit if approved.

The SFMTA and other Bay Area transit operators have initiated planning to consider potential operational, revenue, and efficiency strategies that could be pursued in the absence of new operating funds. In the case of SFMTA, about a quarter of Muni service could be eliminated. Regional transit agencies would also expect to make significant cuts to service by late 2027. This would affect everyone who lives and works in San Francisco, and addressing transit agencies’ operating funding needs is an important consideration in the context of ongoing planning for any transit expansion projects.

Planning, design, and funding of major capital projects such as the Geary/19th Ave Subway take significant time, and progressively advancing planning work is important to lay the groundwork for securing the local, regional, state, and federal funding that will be required in the future to construct and operate the project.

1.1 Study Approach

The San Francisco County Transportation Authority (SFCTA), in partnership with the San Francisco Municipal Transportation Agency (SFMTA) and the San Francisco Planning Department, undertook the Geary/19th Avenue and Regional Connections Study to develop the strategic case for the Geary/19th Ave Subway. This study uses evidence and analysis to address four key questions:

  • What is the broad case for advancing the Geary/19th Ave Subway to the next phase of study?
  • What are the potential benefits unlocked by an investment in a Geary/19th Ave Subway?
  • What are the key decisions that will shape those benefits, such as the project’s route, technology, and other design options?
  • What are the key issues that should be incorporated into the next phase of study?

Combined, these questions enable decision-makers, project partners, and the public to understand the benefits that would be unlocked by the Geary/19th Ave Subway and to guide future phases of project development.

Importantly, this study did not:

  • Select a preferred alternative or advance planning/design beyond a pre-feasibility level
  • Confirm benefits, costs, risks, and timelines for a specific alternative

These decisions will be advanced in future phases of project development, informed by additional analysis and stakeholder engagement, should the project proceed.

The development of the Geary/19th Ave Subway will be a complex multi-phase process spanning multiple years, as illustrated in Figure 1-1. This report supports the robust decision-making that is required to both realize project benefits and manage the cost and complexity of developing a new subway. It is divided into six chapters that guide readers through relevant background information, initial planning work, project performance, essential building blocks, conclusions, and next steps.

Chapter

Content Included

Questions Explored

1. Introduction

Introduces this report, including background on why this work was completed, context on the Geary/19th Ave Subway, and the role of this study in the ongoing development of the project

  • What is the proposed Geary/19th Ave Subway Project?
  • What is the purpose of this report?

2. Issues & Opportunities

Explores the issues, challenges, and opportunities on the Geary/19th Ave Corridor to identify an overarching rationale for a potential subway. These findings set the frame for the design options explored in Chapter 3 and the metrics that are used to evaluate the case for the project in Chapter 4.

  • Why does this corridor need expanded rapid transit?
  • What are the impacts of not improving transit?
  • What types of benefits could be realized by improving rapid transit on the corridor?

3. Subway Design Options

Defines a set of representative options based on key design choices for the Geary/19th Ave Subway: how and if to connect the subway to the regional rail network, what markets to serve, and the technology to use for the project. These choices are used to define a range of design options that are evaluated in Chapter 4.

  • What infrastructure and service improvements could address issues and opportunities identified in Chapter 2?
  • What are the key design choices that future work should consider?

4. Project Performance

Evaluates the representative options defined in Chapter 3 to understand the overall potential performance of a Geary/19th Ave Subway and identify any initial trade-offs of different design choices. This chapter is not intended to select an alternative; rather it presents an envelope of performance for the Geary/19th Ave Subway to make the case for the project and inform future design work.

  • What level of performance could a Geary/19th Ave Subway achieve?
  • How do different design choices impact performance and what are the trade-offs?

5. Other Key Building Blocks

Describes other key elements required to successfully advance and deliver the Geary/19th Ave Subway, including strategies to attract/develop funding and optimize project benefits in the communities it serves.

  • What strategies can San Francisco explore to support funding a Geary/19th Ave Subway?
  • What other supportive policies are important to advance with or alongside further project development?

6. Conclusions & Next Steps

Summarizes the previous chapters into a set of conclusions and recommendations for the Geary/19th Ave Subway and outlines a process and next steps to advance the project.

  • What key insights did this initial phase of work identify?
  • What should decision-makers and stakeholders consider when advancing this project further?

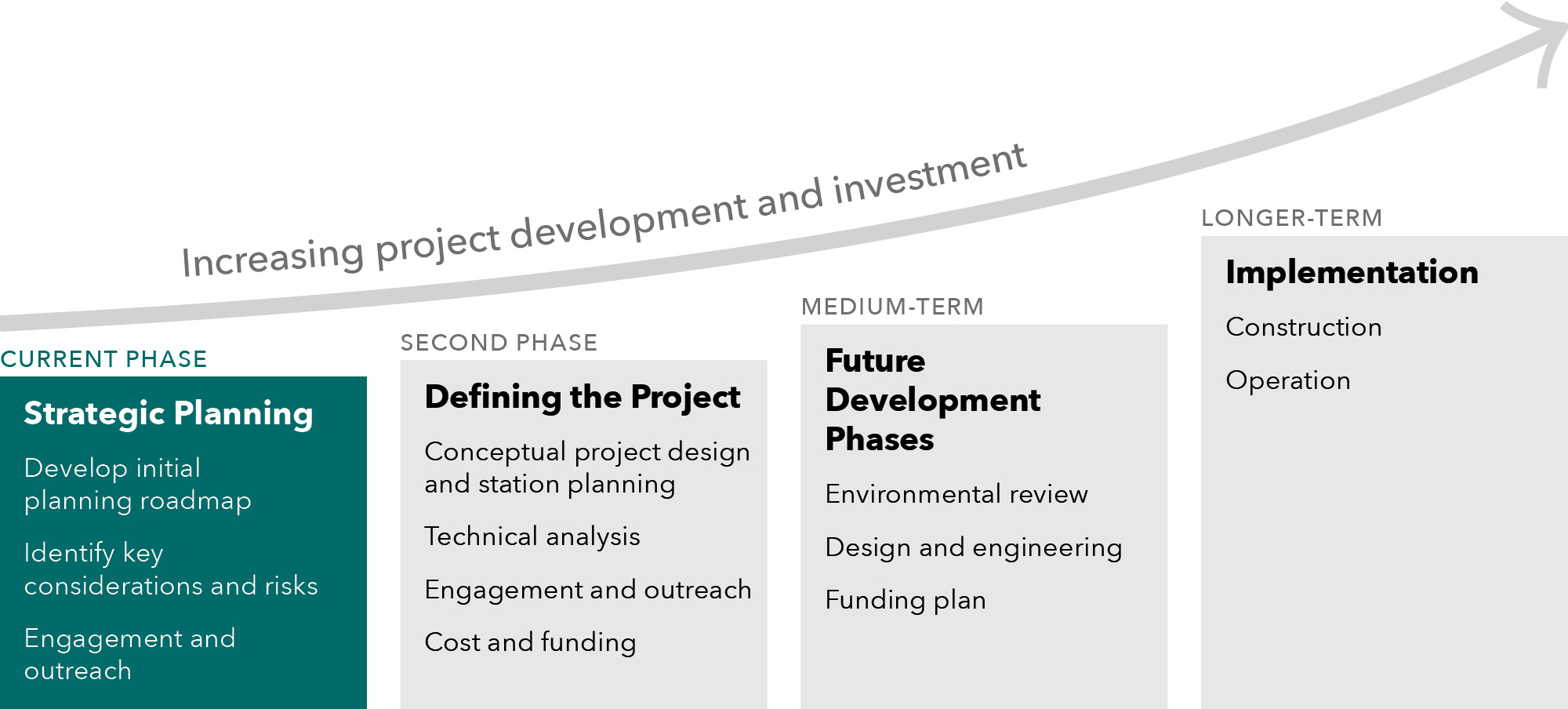

Figure 1-1. Major Project Development Process Overview
A chart illustrating the increasing project development phases and investment, with the current phase as strategic planning, second phase as defining the project, medium-term as future development phases, and the longer-term as implementation.

1.2 Project & Corridor Description

The Geary/19th Avenue Subway, as identified in the ConnectSF Transit Strategy (2021) and the 2050 San Francisco Transportation Plan (2022), is envisioned as a rail rapid transit subway oriented under Geary Blvd and 19th Ave in San Francisco. Prior work has left several open design questions, such as project termini, specific routing in Downtown San Francisco and in the transition between Geary Blvd and 19th Ave, and rail technology. This study has advanced initial understanding of these design considerations. Other project attributes, such as specific station locations and configurations, will be explored in subsequent phases of project development.

The Geary/19th Avenue subway corridor begins in Downtown San Francisco near the Salesforce Transit Center. It continues west through the Western Addition extending potentially as far west as the Inner Richmond, connecting these neighborhoods with regional high-capacity rail. It turns south through Golden Gate Park and continues beneath 19th Avenue connecting the Sunset, Ingleside, Parkmerced, and other nearby neighborhoods. The corridor continues to northwestern San Mateo County, terminating roughly near the existing Daly City Bay Area Rapid Transit (BART) station, with connections to the BART network. The corridor is illustrated in Figure 1-2.

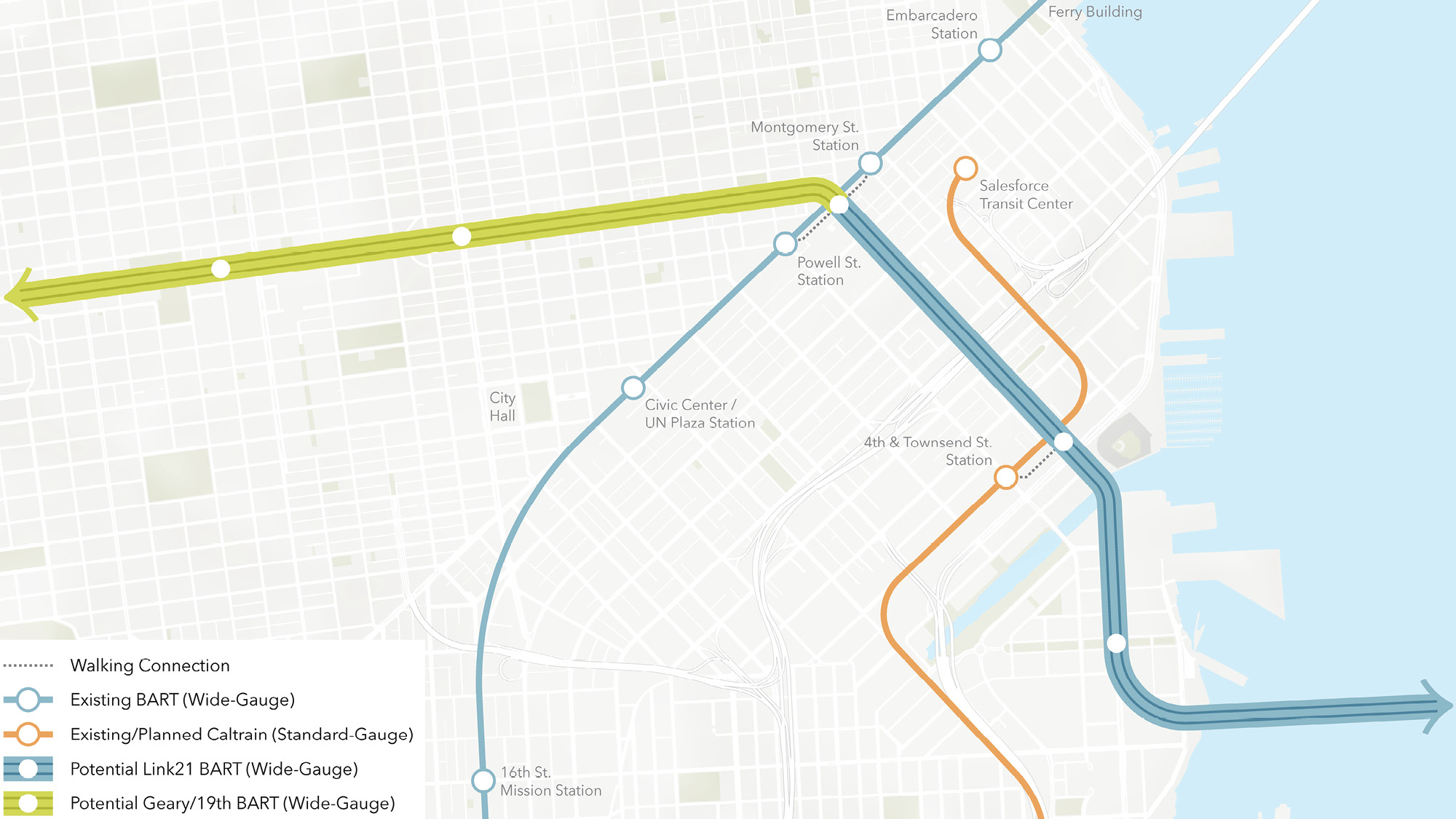

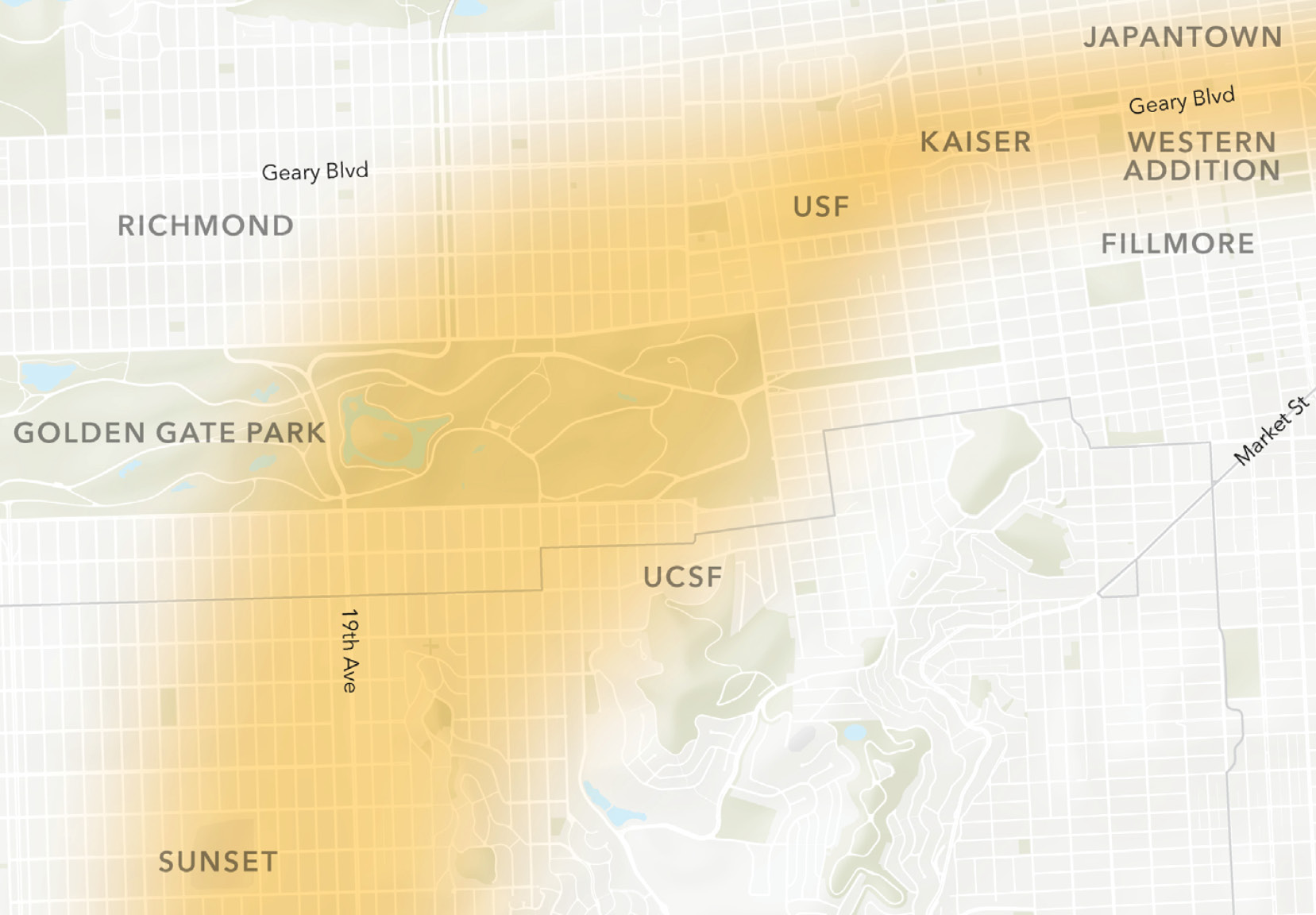

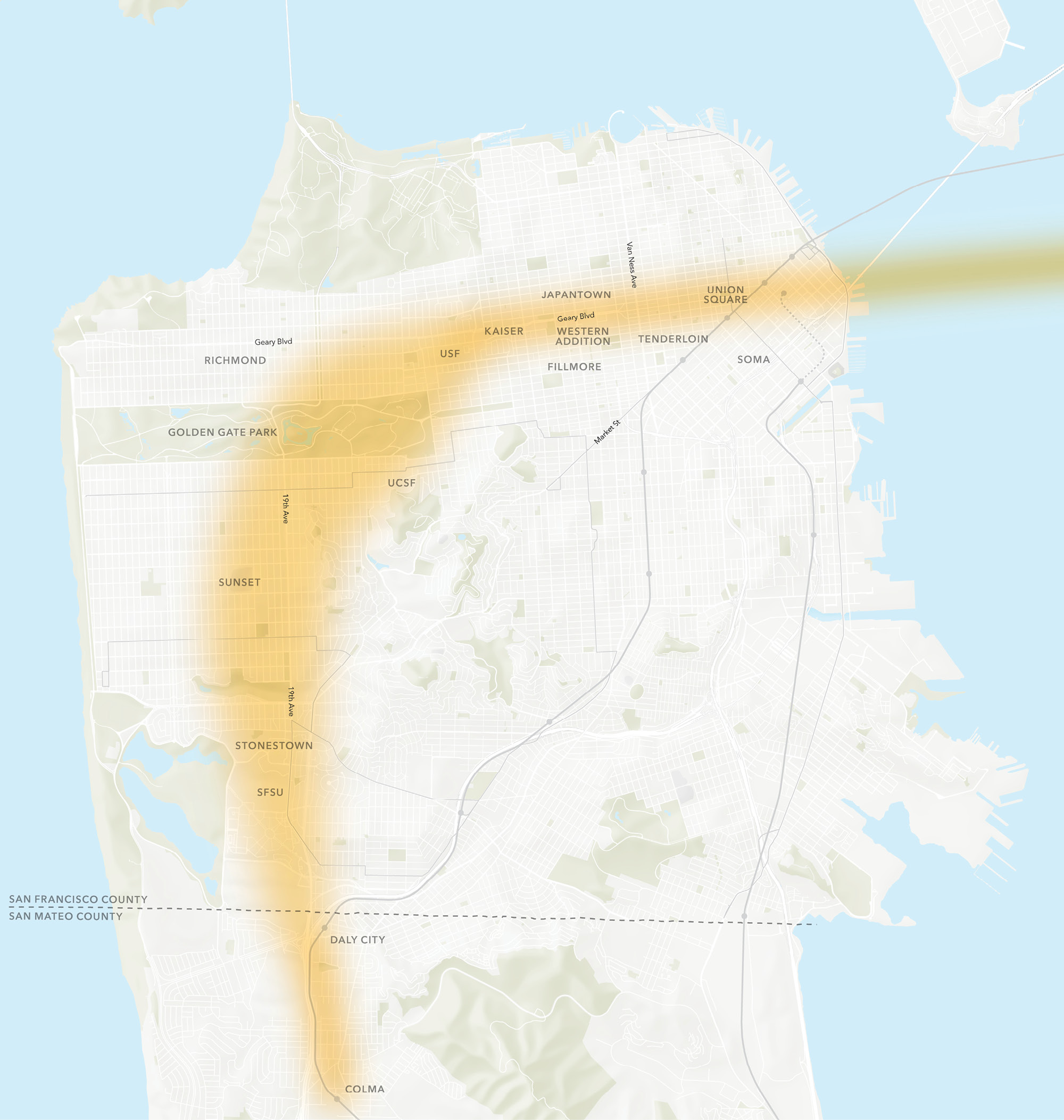

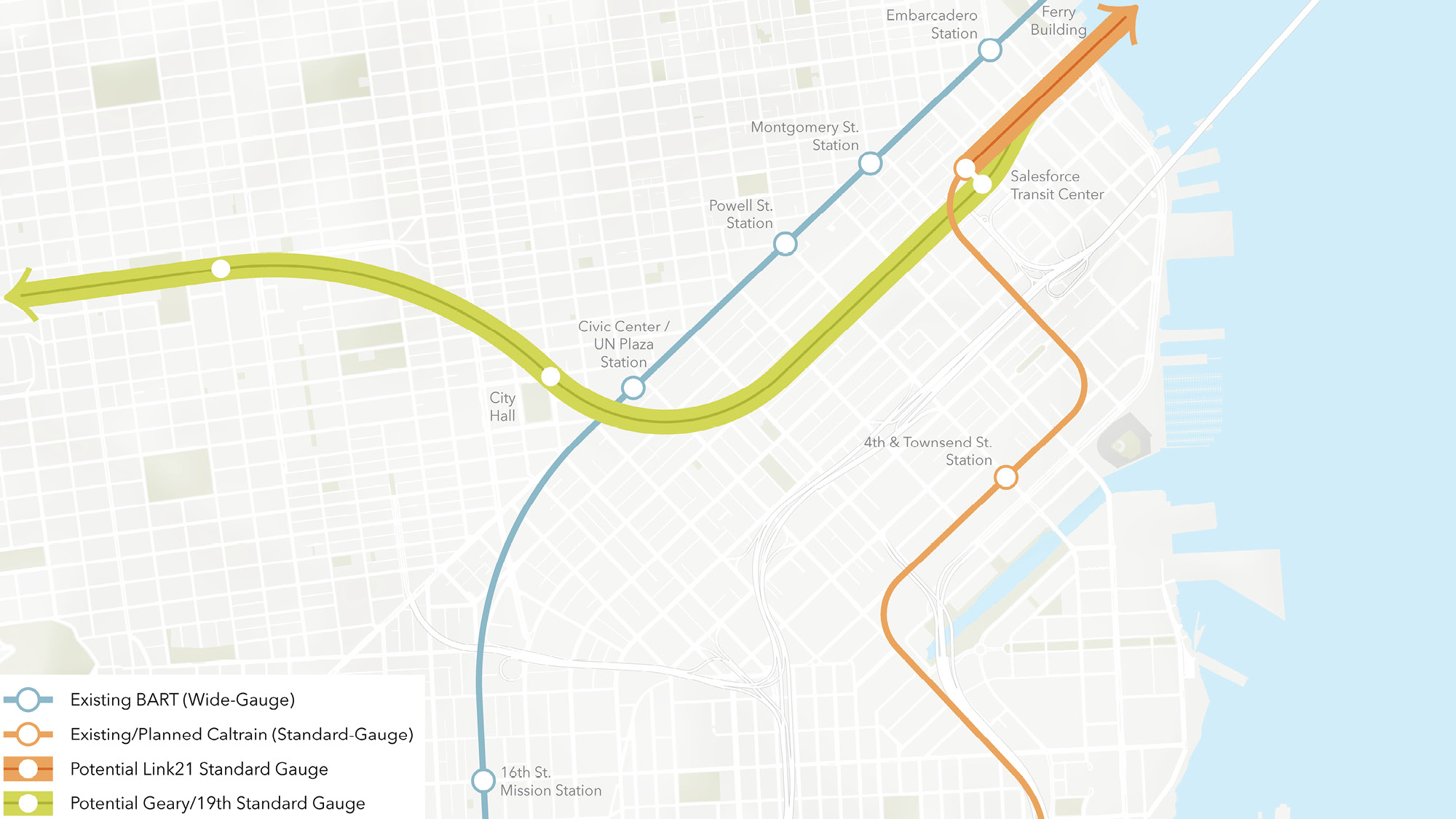

Figure 1-2. Project Study Area Map
A map of San Francisco, with the approximate rail route (along Geary in the east, curving south around Golden Gate Park) area highlighted in yellow.

For the purposes of this analysis, the Geary/19th Ave Corridor encompasses the neighborhoods and destinations approximately ½ mile from Geary Blvd and 19th Avenue in San Francisco, excluding portions of the downtown area (east of Van Ness Avenue) that are well served by transit today.

Issues & Opportunities

Chapter 2 explores the opportunities, issues, and challenges currently facing San Francisco and the Bay Area with respect to the Geary/19th Ave Corridor and anticipates what the impacts could be if they are not addressed.

2.1 Opportunity Statement

The Geary/19th Ave Corridor is critically important for moving people and goods across San Francisco and the wider Bay Area. A Geary/19th Subway provides the opportunity for a high capacity, fast, frequent, and reliable transit service across the corridor and beyond. It can help meet future travel demand, support planned housing development, and better meet the evolving needs of San Francisco and the Bay Area.

Today, the Geary/19th Ave Corridor is home to nearly 29% of San Francisco’s population, 43% of its jobs, and many significant employment, cultural, academic, and social service centers and institutions. Communities along the corridor are anticipated to grow significantly in the coming decades. Population growth planned for in San Francisco’s 2022 Housing Element reflects 100,000 new people and 80,000 new jobs along the corridor.

Travel demand on the corridor is significant. Each day hundreds of thousands of trips are made to places along the corridor or to access other parts of the Bay Area. This high level of travel demand can make transit crowded and roads congested, resulting in slow and unreliable travel times.

Recently, substantial transit priority investments along Geary Boulevard and 19th Avenue have improved reliability along the congested surface network. However, they do not always provide competitive travel times for trips across the entire city or to key regional destinations elsewhere in the Bay Area, nor do they provide the capacity needed to serve future demand. The improvements required to meet these needs are not achievable solely with at-grade transit service. A new grade-separated rapid transit service a subway is needed to provide reliable, fast, frequent, and comfortable mobility and to support the growth expected along the Geary/19th Ave Corridor.

Investments in Geary Boulevard and 19th Avenue Transit Service

Several investments in Geary Boulevard over the last several years have helped to increase bus travel times, improve reliability, and match service to demand.

The Geary Rapid Project, completed in 2021, added new transit lanes, transit signal priority, optimized bus stop locations and bus bulb-outs on Geary Boulevard east of Stanyan Street. These improvements decreased travel times by 18% and improved on-time performance by 37%.

The SFMTA also installed transit lanes west of Stanyan to 32nd Avenue through the Geary emergency transit lanes project (completed 2021) and the Geary Boulevard Improvement Project’s Quick-Build phase (completed 2023). Additional improvements, including paving, colored lanes and bus bulb-outs, will be completed by 2027 and extend those benefits to the Richmond District as far as 34th Avenue.

In addition, the 28 19th Avenue Rapid Project has introduced transit priority treatments including transit signal priority, bus stop consolidation, and wider sidewalks with bus boarding areas that have worked together to improve 28 and 28R speed and reliability.

Even with bus service optimization along both corridors, however, transit journeys along Geary Boulevard and 19th Avenue can range from 45 – 60 minutes or more and include one or more transfers.

2.2 Key Opportunities and Challenges

The opportunity statement for the Geary/19th Subway project summarizes the key transportation and related policy issues faced by people who live, work, study, visit, and travel along the Geary/19th Ave corridor today and in the future. Through a review of existing and future levels of travel demand, the study team identified three overarching goals for the Geary/19th Ave Subway:

  1. Improve the traveler experience and provide better transit service to the corridor, San Francisco, and the Bay Area
  2. Serve current needs and planned growth in the corridor and region
  3. Support crucial regional policy goals of affordability, equity, and the environment

Table 2-1 provides a summary of these opportunities and the challenges identified in achieving them. The following sections provide more detail on each Opportunity and Challenge.

Table 2-1. Geary/19th Avenue Subway Corridor Opportunities and Key Challenges

Opportunity

Key Challenges

Opportunity 1: Improve the transit experience, travel time, resilience, capacity, and connectivity

Challenge 1 — Travel time competitiveness and experience: travel along the corridor can be crowded, slow, unreliable, and congested, particularly for longer-distance trips, resulting in eroded experience and negative traveler impacts.

Challenge 2 — Resilience: The transit system today is susceptible to operational disruptions that leave travelers throughout the system vulnerable to additional delay and crowding. The Muni Metro system, a critical link in San Francisco’s transit network, does not have good alternate options today in the event of an unplanned disruption. Even with investments in transit priority, local north-south transit in Western San Francisco can be susceptible to delays stemming from regional travel and/or special events in Golden Gate Park or Stern Grove.

Opportunity 2: Serve current needs as well as planned growth in the corridor

Challenge 3 — Growth and Changing Needs: significant growth was identified for the corridor in the San Francisco Housing Element, adopted in 2022, and will be enabled by the Family Zoning Plan, approved in 2025. Travel patterns will evolve alongside changes to where people live, work, and travel. In the long term, this growth will put increased strain on infrastructure and service that cannot be managed with today’s transit network.

Challenge 4 — Jobs and Economic Development: the corridor is home to major universities, hospitals, cultural institutions, and employment areas. However, the corridor is not fully connected to the rest of San Francisco and the region, which may impede economic opportunities and regional accessibility.

Opportunity 3: Support Crucial Regional Policy Goals

Challenge 5 — Climate and Environment: the corridor’s transportation network is auto-oriented, with some of the highest vehicle miles traveled per capita in San Francisco. Change is required to meet climate and air quality targets.

Challenge 6 — Affordability and Equity: the region’s transit network does not meet the transportation needs of all travelers and could better contribute to broader strategies for equity and housing affordability.

2.2.1 Improve the Traveler Experience

In recent years, significant investments have been made to improve surface (bus) transit in the corridor. These investments have included the Geary Rapid Project and the Geary Boulevard Improvement Project, as described above. In the future, and as the corridor and region continue to grow, grade separated rail transit a subway will be needed to take service to the next level of capacity, quality, and consistency while providing faster and more direct journeys. Current conditions along the Geary/19th corridor sometimes do not meet traveler needs today, and with anticipated growth, will not meet traveler needs in the future. Two key challenges illustrate this need:

  • Challenge 1: Travel along the corridor can be crowded, slow, unreliable, and congested, resulting in eroded experience and negative traveler impacts.
    • Transit ridership along the Geary segment exceeds crowding thresholds in the peak period and peak direction today, with higher crowding anticipated in the future despite continued improvements to service.
    • Transfers are required to reach key regional destinations, sometimes to less frequent routes, adding to overall journey time.
    • Transit travel times are roughly twice auto times, and connections to San Mateo County destinations are not well served, making transit a less attractive option.
  • Challenge 2: The transit system today is susceptible to operational disruptions that leave travelers throughout the system vulnerable to additional delay and crowding
    • The Muni Metro system, a critical link in San Francisco’s transit network, does not have good alternate options today in the event of an unplanned disruption
    • Even with investments in transit priority, local north-south transit in Western San Francisco is susceptible to delays stemming from regional travel along 19th Avenue and special events in Golden Gate Park or Stern Grove.

Travel Time and Experience: Negative Impacts by the Numbers

Without improvement, by 2050:

  • Transit in the corridor will move at about half the speed of automobiles (10 MPH vs 19 MPH)
  • Using transit for trips between the corridor and other key regional destinations may take twice as long as driving or more, including:
    • San Francisco State University to Geary & Fillmore is roughly 58 minutes
    • Emeryville to Golden Gate Park is roughly 95 minutes, with multiple transfers
    • The Sunset to Redwood City is 120 minutes, with multiple transfers

2.2.2 Serve Current Needs and Planned Growth in the Corridor and the Region

Significant growth is planned along the corridor, and travel patterns will evolve as changes occur with respect to where people live, work, and travel. Growth will put increased strain on transit infrastructure and service that cannot be fully accommodated with today’s network; this could result in greater crowding, congestion, and increased Vehicle Miles Traveled (VMT) that would make realizing this growth more challenging. The corridor is also home to major universities, hospitals, cultural institutions, and employment areas; however, it is not fully connected to the rest of San Francisco and the region, which constrains economic opportunities. Two key challenges illustrate this need:

  • Challenge 3: With planned growth and changing needs, demand for travel will exceed available service capacity
    • By 2050, the population in neighborhoods served by the Geary/19th corridor is planned to grow by up to 56% as part of San Francisco’s commitment to welcome over 80,000 new households citywide.
    • Trips to, from, and within the corridor are expected to increase significantly by 2050, placing strain on the existing network
      • Trips along the Geary/19th corridor are expected to increase substantially. Trips originating along the corridor will increase by at least 30 percent to the Western Addition (37%), Richmond (42%), and Outer Richmond (30%).
      • The Southwest and South of Market neighborhoods are both proposed for major residential and commercial development by 2050 and will see over 60% increases in travel demand from the Geary and 19th Avenue corridor neighborhoods.
      • The Peninsula and South Bay, including San Mateo County, are major origins and destinations for travel in the Geary and 19th Avenue corridors. Trips from Geary neighborhoods to the Peninsula/South Bay will increase by about 30%.
  • Challenge 4: Key employment centers and activity centers on the corridor are not well connected with the regional transit network. This may impede the success of these institutions, and limit the ability of job-seekers and students to access new opportunities.
    • The lack of good connectivity to the rest of San Francisco and the broader region limits growth opportunities for important community institutions and creates barriers for people to access employment and educational opportunities at the universities and hospitals served by the corridor.
    • More than 30% of the jobs in San Francisco are located along the non-downtown portions of the corridor, though for many residents of the Bay Area, especially those in Equity Priority Communities, accessing these jobs requires transit trips of over 45 minutes.

2.2.3 Support Crucial Regional Policy Goals

Environmental protection is a long-standing regional and statewide goal that requires a full complement of strategies to address from land use and transportation to electrification and decarbonization. A Geary/19th Ave Subway would play an important role in contributing to these strategies. The following challenge illustrates this need:

  • Challenge 5: Climate and environmental targets may not be met
    • State and regional climate goals focus in part on the reduction of Vehicle Miles Traveled (VMT) in order to reduce Greenhouse Gas (GHG) emissions in the transportation sector. In order to achieve these goals, high quality transit alternatives must be competitive with driving. Without proper infrastructure, service, and connectivity, the transit network cannot provide an attractive alternative.
    • Today and in the future, portions of the Geary/19th corridor have the highest rates of VMT per capita in San Francisco, driven partly by land use and travel patterns more closely connected to destinations in San Mateo County that are not as well served by transit.
    • These high VMT per capita areas contribute a disproportionate share of San Francisco’s greenhouse gas emissions and air pollution. Residents are also exposed to the local effects of particulate matter and NOx pollution as a result of their proximity to high-volume arterials serving both local and regional travel.
  • Challenge 6: The region’s transit network could better support equity and housing affordability
    • The Bay Area’s transit systems play a key role in ensuring that accessible housing is part of a ‘complete solution’ to affordability, quality of life, and equity issues. However, for some residents and workers, the current transit network does not provide efficient access between areas with high concentrations of jobs and locations with housing that is more affordable.
    • San Francisco approved the Family Zoning Plan in 2025, which provides for growth in housing in the neighborhoods directly within or adjacent to the project corridor. Without investments in infrastructure that increase capacity and decrease travel times, the City may face challenges in meeting its commitments to plan for over 80,000 new housing units in the years ahead.

2.3 Acting on Opportunities and Addressing Challenges

The opportunities and challenges described in this chapter were used by the study team for the development and assessment of potential project choices, with consideration of implications for transit riders, communities in San Francisco and northern San Mateo County, and the wider region. Each opportunity was also considered with an equity lens, with analysis to understand the magnitude of benefits realized by residents of Equity Priority Communities (EPCs).San Francisco’s Equity Priority Communities include a diverse cross-section of populations and communities that could be considered disadvantaged or vulnerable now and in the future. Equity Priority Communities can have high levels of households with minority or low-income status, seniors, people who have limited English proficiency, people who have disabilities, and more. For more information on how Equity Priority Communities are defined and to explore a map of their locations, see https://www.sfcta.org/policies/equity-priority-communities

Planning work completed for this phase aimed to describe an “envelope of performance” with respect to the set of metrics that illustrate the project’s effectiveness in addressing the challenges. These metrics were used to evaluate the potential subway in Chapter 4, both to make the case for the Geary/19th Ave Subway, and to explore how different alignment choices and other scope choices impact the benefits of the project.

The analysis in this phase both in establishing the challenges and opportunities and evaluating project performance, is based on the best available assumptions for long-range forecasts. These analyses should be revisited as the project continues to develop to ensure that the project still addresses the challenges and delivers benefits effectively, to justify entering future phases of work and committing the additional resources required to do so.

Subway Design Options

The Study has preliminarily identified potential major subway design features and key tradeoffs in configuration, performance, and relative cost. Analysis and decisions about alternatives will be made in subsequent phases of study, but a preliminary assessment of high-level tradeoffs by project segment are explored in the sections below.

3.1 Considerations for the Universe of Options

Building on the high level, conceptual project definition laid out in the ConnectSF Transit Strategy, the study team identified major design choices for the subway and how each could result in potential tradeoffs that will need to be addressed or resolved in subsequent project phases. Through a series of workshops with agency (SFCTA, SFMTA, and SF Planning) staff, the study team identified three key topics of consideration to inform the potential universe of alternatives for a Geary/19th Ave Subway:

  • What are the key destinations that a Geary/19th Ave Subway should serve?
  • How should a Geary/19th Ave Subway connect to or integrate with the existing and planned regional rail network?
  • What rail technologies are well suited for the operational and service requirements of the Geary/19th Ave Subway?

These questions are often interrelated and overlapping, and optimizing across them will require refinement of technical tradeoffs and coordinated decision-making as the project advances through further development.

This phase of work has examined an initial range of routing and station location considerations across the corridor, as well as in three focused areas within the corridor:

  • Downtown San Francisco;
  • The connection between Geary Blvd and 19th Ave portions of the corridor; and
  • The southern terminus of the project in northern San Mateo County.

The sections below discuss the key choices, benefits, and tradeoffs associated with each segment of the subway.

3.1.1 Regional Context and Coordination

Both the ConnectSF Transit Strategy and the 2024 California State Rail plan envision the Geary/19th Ave Subway as an important link in the Bay Area and Northern California rail network, and this future western San Francisco opportunity has been highlighted in the Link21 Market Analysis and the State Rail Plan. By connecting western San Francisco to and from the broader region, via a new transbay rail crossing to the East and integration with existing rail extending to the south, the subway would bring direct regional rail service to some of the densest and fastest growing portions of the region over the coming decades.

To this end, this study considered modes that could deliver frequent, high capacity metro-like service in the corridor while also being interoperable and allowing through-running with one of the two primary modes of regional rail operating in the Bay Area today:

  • BART technology that is, broad gauge, heavy rapid transit; and
  • Electrified, standard gauge regional rail technology.

Other rail technologies could potentially meet the capacity and frequency requirements of the corridor while requiring a transfer to access the broader regional rail system. These other options include Muni LRV (Muni Metro) technology and automated light rail transit or ALRT (which has been implemented in Vancouver, BC, among other regions). Rail technology options and their implications for the project are described further in Section 3.1.6, below.

Achieving regional connectivity will require the alignment of technology choices, as well as ongoing coordination, with other efforts, including Link21, The Portal, and the State Rail Plan. Certain technology decisions made by other projects may constrain the set of choices for routes, station locations, and other project attributes available to decision-makers in future phases of planning. For example, while it may be possible to through-run standard-gauge regional rail trains from the East Bay to the Geary/19th Subway, it is unlikely that they would be able to continue into San Mateo County without significant additional expense and disruption due to the lack of an existing standard-gauge alignment along the western Peninsula.

Link21 and Standard Gauge Rail

In June 2025, the Link21 project team recommended Standard Gauge rail as the technology choice for the new rail crossing of the Bay. For the purposes of this strategic case, we evaluated the potential of both BART and Standard Gauge technology options in the crossing to consider the technical, performance, and strategic implications of each. As both projects continue to advance, ongoing coordination will be necessary to understand the potential benefits, costs, and trade-offs for how the two mega-projects could interface for users as well as for system owners/operators assessing operational/system impacts, funding, and constructability, among other implementation questions.

As one example of this decision-making complexity, the ability to connect to the rail system outside of San Francisco will be an important consideration when determining the size, shape, and location of the vehicle storage and maintenance facility or facilities that would be needed to support service. A fully interconnected system could potentially leverage existing or expanded regional storage and maintenance facilities, or take advantage of co-location opportunities in coordination with other projects (such as a new transbay crossing). Potential sites for a new facility within or adjacent to San Francisco are relatively limited but should also be considered in a future study phase.

3.1.2 Corridor-wide Subway Design Considerations

The Geary/19th Ave Subway is envisioned to provide high capacity, frequent metro service that would be supported by bus services connecting to and supplementing transit capacity in the subway corridor, similar to the Mission, Market, and Central Subway corridors.

Across the corridor, decisions regarding station locations and station spacing will correspond with the technology selected and as such, the options involve tradeoffs between station spacing, design/travel speed, fleet maintenance requirements, and costs of construction and operation. Based on existing and planned densities of housing, population, jobs, and other attractions, the subway alignment and station plans could vary but the study team anticipated stop spacing between 0.5 and 1 mile, in line with the ranges currently seen on the BART system within San Francisco (approximately 0.5 miles on the Mission corridor, and approximately 1 mile between Glen Park, Balboa Park, and Daly City). Each station comes with significant cost to construct, and all stations on the project should be transit supportive in terms of access and land use, with thoughtful planning to mitigate risks of displacement and community instability.

3.1.3 Downtown San Francisco

The Geary/19th Ave Subway’s configuration and routing through Downtown San Francisco is closely related to the policy choices that must be made regarding regional interoperability and integration discussed above. Should through-running of trains to the East Bay be a priority, the project will need to develop an integrated approach with the Link21 program’s new transbay crossing.

Mission Bay / 3rd Street / Geary Boulevard Alignment

If a new transbay rail connection is routed via Mission Bay and 3rd Street terminating near Market Street, as shown in Link21’s representative concept for BART technology, the Geary/19th Ave Subway would likely continue straight west under Geary Blvd towards Van Ness, the Western Addition and Japantown. This option would provide a slightly shorter travel time than the Howard Street / Salesforce Transit Center alignment described below, and passengers could connect to the existing Market Street subway at Powell/Union Square or Montgomery, as well as to the Salesforce Transit Center with a short walk. This configuration is illustrated in the figure below, with Green representing the Geary/19th Ave Subway using BART technology and Blue representing Link21 BART technology subway.

Figure 3-1. Mission Bay / 3rd Street / Geary Boulevard Alignment
A map showing a potential rail route through Geary and 3rd Street, with the approximate rail routes shown with thick arrows in green going west and blue going east, with green representing the potential route of a Geary/19th Ave Subway under Geary Blvd and Blue representing the potential route of a New Transbay Rail Crossing with BART technology under 3rd Street and Mission Bay.
Howard Street / Salesforce Transit Center Alignment

If a new transbay rail connection is routed via Howard St terminating at or around the Salesforce Transit Center, as shown in Link21’s representative concept for a standard gauge regional rail technology, the required depth and tunnel turn radii would likely require a routing via the Civic Center station area before turning back north towards the Western Addition and Japantown. Additionally, this option would likely require the construction of additional underground platforms at or near the Salesforce Transit Center, which could prove challenging in the built-out urban environment, above and below ground, in this area. This option would provide a slightly longer travel time than the Mission Bay / 3rd St / Geary Blvd alignment described above, but would enable direct service to the concentration of residents and jobs near Civic Center. Passengers could connect to the Market Street subway and Van Ness BRT at the Civic Center station, and downtown passengers could connect to the Salesforce Transit Center or to Montgomery or Embarcadero stations with a short walk. This configuration is illustrated in the figure below, with Green representing the Geary/19th Ave Subway using Standard Gauge Regional Rail technology and Orange representing a Link21 Standard Gauge Regional Rail subway.

Figure 3-2. Howard Street / Salesforce Transit Center Alignment
A map showing a potential downtown rail route through Civic Center and Howard, with the approximate rail route shown with thick arrows in green going west and orange going northeast. Green arrows represent a potential Geary/19th Ave subway from the Salesforce Transit Center via a route under Howard, to Civic Center, and then to Geary/Fillmore and beyond, while the orange arrow represents a potential New Transbay Rail Crossing with Regional Rail technology under Howard Street between the Salesforce Transit Center and the East Bay

3.1.4 Connecting between Geary Blvd and 19th Ave

ConnectSF identified a broad area in which the connection could be made between the portion of the subway under Geary Blvd and the portion under 19th Ave, contemplating turning south between Masonic and Park Presidio, based on demand, land use, cost, and constructability considerations. While there are numerous discrete options that could be available within these bounds, a set of key tradeoffs has emerged to illustrate the choices at hand in this area.

By hewing more to the east, potentially turning at or near Masonic, the subway could directly serve areas with existing established residential density, such as Japantown and the Western Addition, Kaiser Hospital, and important regional destinations like the University of San Francisco and UCSF. These areas, however, are also already served by a higher density of transit than points further west, and enjoy relatively short travel times to and from Downtown today.

By continuing further west under Geary Blvd before making a turn, the subway would have the opportunity to directly serve areas not well linked to regional transit today, shortening journey times to and from the Richmond, as well as to important regional destinations like Japantown, the Western Addition, Kaiser Hospital and the University of San Francisco, as all alignments would. A number of options in the middle would serve housing growth areas while still enabling faster regional connections to places like Golden Gate Park, the Inner Sunset, and UCSF, all of which draw regional visitors and local trips.

Figure 3-3. Area of Potential Routes to Connect Geary Boulevard and 19th Avenue
A section of a map of San Francisco with a yellow shaded area showing the potential rail route through several neighborhoods and key destinations including the Sunset, UCSF, Richmond, USF, Kaiser, Japantown, Western Addition, and the Fillmore.

Regardless of the eventual final alignment, it will be important to advance the project in concert with continued citywide and neighborhood planning efforts. Subways are a major public investment, and supportive land use maximizes their ridership and benefits. On the whole, San Francisco’s plans to deliver more housing and increase affordability and accessibility create a clear need for enhanced transit options in the project corridor.

In assessing potential options in this part of the corridor, the project team should consider the full transit network and connecting bus services, including Muni and Golden Gate Transit. While a new subway may not directly serve a neighborhood or destination, it would still reduce travel time, crowding, and delay for transit riders on and off the corridor, by offering the opportunity to transfer to a faster and more reliable service to complete the trip (or the option to do so at a closer location than may exist today). For example, trips beginning west of 19th Avenue and heading towards the East Bay would have the opportunity to transfer to regionally connected rail along Geary itself, rather than remaining on surface bus or light rail transit all the way to Market Street and the Salesforce Transit Center, as they would today.

3.1.5 Southern Terminus

The approach to connecting the Geary/19th subway with the regional rail network (BART) near the San Francisco/Daly City border will be driven by both technology choices and topography.

A technology choice of BART for the project would allow trains serving the Geary/19th subway to continue along the existing BART alignment south to San Francisco International Airport and Millbrae for a connection with Caltrain and future California High-Speed Rail service. A standard gauge regional rail option, or the Muni Metro or ALRT options, would require a passenger transfer at or around either the Daly City or Colma stations. These technologies would also narrow the options for the siting and configuration of the required supporting maintenance facility, which are not yet determined.

The topography of the southern terminus location also presents a tradeoff between a seamless transfer and an entirely “subway” configuration. The existing Daly City station is elevated, and given the topography heading north on the existing BART line, changes to this configuration would be challenging. As such, it is likely that both through running and transfer options for the Geary/19th Subway would need to surface and transition to an elevated alignment near the 19th Ave / I-280 freeway interchange before crossing into Daly City. It is possible that the need for this new structure could be reduced by designing transfers at or around the existing Colma station, but the costs of this approach may be prohibitive, including potential impacts to BART’s storage and maintenance yard at the Colma station.

3.1.6 Technologies

The Geary/19th Ave Subway Opportunity Statement (presented in Chapter 2 of this report) identifies the need for frequent, high-capacity metro-like service in the corridor. The study team reviewed multiple rail-based technologies that could meet this need. Four options were identified:

  • BART broad gauge, electric rapid transit technology, using Federal Transit Agency (FTA) certified electric multiple unit (EMU) train sets and third rail power systems. BART technology would enable the through running of trains south to San Mateo County to SFO/Millbrae. There would also be the potential for through running to the East Bay if BART technology were accommodated in a second transbay crossing.The Link21 Program evaluated the viability of a rail connection between the existing Market Street Subway and a potential new branch line, and determined options which include this element to be infeasible. Both BART and Muni Metro subway service would be taken offline for at least 1 – 2 years to facilitate construction and tie-in, and limited right-of-way would create turns of unacceptable radius. Additionally, creating a merge and diverge point in the busiest part of the system would impact service reliability and availability throughout the remainder of the network.
  • Electrified standard gauge regional rail compatible technology, with Federal Railroad Administration (FRA) compliant vehicles configured in a single level, high capacity, multiple door layout.The study team found that a single level, high capacity, multiple door layout would best deliver metro-like service and frequencies, as these elements allow for shorter station dwell times, easier boarding and alighting, and a seating layout more conducive to short trips than longer regional or intercity trips, which would be better served by equipment in use on Caltrain or the Capitol Corridor, respectively, today. This technology could potentially allow through running to the East Bay if standard gauge were accommodated in a second transbay crossing.
  • Light Rail (Muni Metro) is a technology currently in use in San Francisco, serving both subway and surface alignments through the city, centered on the Market Street Subway and Central Subway trunks. While this option could leverage shared fleet and maintenance facilities, the Geary/19th Ave Subway is not envisioned to directly connect to existing Muni Metro lines in revenue service. This option cannot interoperate with regionally connected services beyond San Francisco, but it could potentially meet the operational needs of the corridor itself, particularly if connected to the regional network with well-designed passenger transfer facilities.
  • Automated Light Rail (ALRT) is not currently in use in San Francisco or the Bay Area, but has been deployed elsewhere in North America (most notably in Vancouver, British Columbia), Asia, and Europe. Like Light Rail (Muni Metro), this option cannot interoperate with regionally connected services outside of San Francisco, but could potentially meet the operational needs of the corridor itself, with the same requirement for well-designed passenger transfer facilities at both termini. ALRT would potentially provide the opportunity to deploy high frequency service while reducing the size of stations, though it would require its own operations and maintenance facility that could not be shared with other existing modes.

Rail technologies differ in several other important ways that influence scope, including cost and operations and maintenance facilities, as shown in Table 3-1.

Technology choice is interrelated with decisions made for interoperability and through-running services. For example, while it may be possible to through run standard gauge regional rail trains to the Geary/19th Ave Subway, they would not be able to continue into San Mateo County without significant additional expense.

Each technology can be deployed to provide a similar speed, capacity, and level of service in a unique way, with trade-offs on capital and operating costs. For example, a Light Rail or ALRT system may have shorter trains but offer higher frequency to achieve a similar capacity when compared to a BART or standard gauge system that may use longer trains operating less frequently.

As discussed in Section 3.1.1, the choice of technology and its relationship to existing networks will also have bearing on the potential location and size of the subway’s operations and maintenance facility, which will be required in order to provide service. Available sites for this facility estimated to require 1020 acres of level ground accessible from the subway are extremely limited in San Francisco and Northern San Mateo County. The choice of technology could affect the project’s ability to leverage existing sites, depending on through-running configuration.

Table 3-1. Comparison of Rail Technologies

Technology

Advantages

Considerations

BART

  • Higher capacity potential with longer trains — longer trains can carry more passengers at a given frequency.
  • Interoperability with existing BART rolling stock and facilities — this may allow for economies of scale in maintenance and operations.
  • Potential for through running with Link21 if BART technology were adopted for the transbay crossing — this would allow for seamless transfers and integrated service with other BART lines in the East Bay.
  • Allows for through running to SFO and Millbrae in San Mateo County.
  • Generally higher construction costs due to the longer platform lengths used by BART
  • Alignment constraints imposed by BART train lengths
  • Potential influence of BART operational characteristics on overall service planning in a through-running scenario

Regional Rail

  • Higher capacity potential with longer trains — longer trains can carry more passengers at a given frequency.
  • Potential for through running with Link21 if regional rail technology is adopted for the transbay crossing — this would allow for seamless transfers and integrated service with other regional rail lines in the East Bay, and could reduce the need for a new maintenance facility in the West Bay.
  • Potential need for a separate maintenance facility, unless Link21 is progressed with standard gauge technology and uses a fleet type suitable for the San Francisco context.
  • Potential for providing higher capacity through increased service frequency or longer trains.
  • Possible use of a unique standard-gauge fleet, distinct from other regional rail services (example: single-level instead of bi-level).
  • Alignment constraints due to standard gauge design requirements.

Light Rail (Muni Metro)

  • Potential for lower station and tunnel costs with shorter Muni Metro fleet — shorter trains allow for reduced station platform lengths, which decreases construction costs though may limit capacity. In tunnels, a smaller diameter may be possible, further reducing costs.
  • Smaller turning radii — this allows the light rail system to navigate tighter curves in urban environments, providing more flexibility in alignment and potentially reducing right-of-way needs.
  • Interoperability with the existing Muni system — this allows for the sharing of maintenance facilities, rolling stock, and operational expertise, which can reduce capital and operating costs, and streamline operations.
  • Potential need for very high service frequencies to achieve target capacity with current Muni train types and lengths
  • Incompatibility with Link21 or BART systems, and no potential for through running to the East Bay or San Mateo County.

Automated LRT

  • Potential for lower station and tunnel costs with shorter ALRT trainsets — shorter trains allow for reduced station platform lengths, which decreases construction costs though may limit capacity. In tunnels, a smaller diameter may be possible, further reducing costs.
  • Smaller turning radii — this allows the light rail system to navigate tighter curves in urban environments, providing more flexibility in alignment and potentially reducing right-of-way needs.
  • Potential need for very high service frequencies to achieve target capacity
  • Would require new dedicated operations and maintenance facility accessible from project alignment that could not be shared with other existing technologies.
  • Incompatibility with Link21 or BART systems, and no potential for through running to the East Bay or San Mateo County

3.1.7 Costs & Phasing

The study team developed high-level, rough order of magnitude cost estimates encompassing the range of design considerations described in this chapter. Based on anticipated and actual costs of recently completed or funded peer rapid transit subway projects in California and North America, the initial cost estimate range is intended to be indicative of potential capital costs, and was used to inform the overall findings of this current study and subsequent phases of project development.

Based on these factors, the capital cost for the Geary/19th Ave Subway, including design and engineering, is estimated to be in the range of $20 billion to $30 billion in 2026 dollars. Key people driving of this range are per-mile tunneling and per-station construction costs; the estimates provided in this phase do not include supporting facilities, right-of-way, financing costs, or escalation.

A project of the scale, scope, and cost of the Geary/19th Ave Subway will need to consider how to potentially phase implementation (and thus, costs and funding needs) over multiple years. Subsequent project development efforts should consider the definition of a potential initial operating segment with independent utility. These initial segments could bring project benefits to travelers and communities sooner, while also preparing the full project for completion. This phasing assessment should also consider the cost and funding implications of any potential phased approach. For the Geary/19th Ave Subway project and corridor, future choices regarding train technology and regional integration will shape the range of potentially viable phasing options.

Project Performance

This chapter explores the benefits of the Geary/19th Ave Subway and core building blocks to advance. It presents findings across a range of design choices, as explored in Chapter 3, to show the potential envelope of performance of the project and illustrate how the design choices may influence that performance.

4.1 Evaluation Approach

The design choices discussed in Chapter 3 were used to develop a set of Conceptual Design Options for analysis. Importantly, these Conceptual Design Options are not ‘alternatives’ for a Geary/19th Ave Subway for review and decision-making. They have been developed at a high level suitable for this strategic case, including:

  • Rough-order-of-magnitude cost estimate ranges derived from benchmarks from peer projects
  • Sketch-level engineering concept designs to identify key risks, challenges, or fatal flaws for stations and alignment
  • Travel demand modeling to describe the range of expected project benefits

The Conceptual Design Options included a San Francisco only subway alignment, with no regional integration beyond a passenger transfer, which tested both downtown alignments discussed in Chapter 3 as well as various options for the turn between Geary Blvd and 19th Ave. The top performing San Francisco-only alignments were then tested with through-running to San Mateo County only, through-running to the East Bay-only, and finally, through-running to both San Mateo County and the East Bay.

Because the performance of each technology can be optimized to deliver similar travel times and service levels along the corridor, this study’s analysis utilized a representative set of operational characteristics (frequency, speed, dwell times) to reflect rail rapid transit service in the corridor and the project’s broad performance. Specifically, depending on the exact design option, the analysis assumed:

  • 56 stations along an approximately 10 mile corridor
  • Peak frequency of 24 trains per hour, per direction
  • End to end travel times (Daly City to Downtown San Francisco), including station stops and dwell time, of 16 to 19 minutes.

4.2 Benefits Assessment Methodology

All benefits included in this case are evaluated qualitatively and quantitatively using:

  • Current information including regional population, employment, transit usage, and planning data sets
  • Future, long-range forecasts from the SF-CHAMP model conducted by SFCTA
  • Planning documents including Plan Bay Area and the 2022 San Francisco Housing Element

This analysis is included to illustrate the potential envelope of performance for a Geary/19th Ave Subway, based on the Conceptual Design Options. Future analysis will include updated benefits based on additional forecasts and design work, including further analysis of benefits required in regional, state, and federal government funding applications and grants.

Corridor and Regional Population, Employment, and Land Use Assumptions

In light of the generational investment represented by a subway, this study utilized long-range planning assumptions consistent with recently adopted land use policies. All analysis conducted for the Strategic Case used growth forecasts from the 2022 Housing Element Update’s Environmental Impact Report. These forecasts reflect the delivery of 82,000 new housing units in San Francisco, and the study's analysis assumed the recovery of ridership from the COVID-19 pandemic. The forecast assumptions used reflect adopted city policies and are appropriate for assessment of the magnitude of benefits a long-term investment like a subway would provide. Future project phases will continue to update these assumptions over time, in coordination with local, regional, and state level plans and policies.

The study team evaluated the performance of the Geary/19th Ave Subway, and the potential design options discussed in Chapter 3, against a set of metrics developed to illustrate how and to what extent the project would address the opportunities and challenges and deliver the benefits identified in Chapter 2. Full metrics are provided in the Geary/19th Ave Subway Performance Analysis Technical Memorandum, and are summarized below:

  • Ridership: Total passengers on project, total new transit riders, total transit mode share, change in vehicle miles traveled
  • Travel Time: Change in travel time, change in crowding on select transit lines, total minutes of crowding experienced
  • Accessibility: Number of jobs accessible, on average, within 45 minutes, change in number of employees who could access jobs-rich areas within 45 minutes
  • Air Quality: Change in greenhouse gas emissions, reduction in relevant pollutants
  • Equity: Distribution of benefits accruing to residents of Equity Priority Communities (EPCs)

4.3 Project Benefits & Analysis Results

The Geary/19th Ave Subway has the potential to contribute significantly to improvements across the project’s three key goals:

  1. Improve the traveler experience and provide better transit service to the corridor, San Francisco, and the Bay Area
  2. Serve current needs and planned growth in the corridor and region
  3. Support crucial regional policy goals of affordability, equity, and the environment

The following sections will explore the results of the analysis in more detail. Key project benefits, and illustrative results, are summarized below:

  • Grow transit ridership in SF and across the region: Serve 162,000 to 314,000 trips a day, including 62,000 to 106,000 net new transit trips.
  • Improve customer experience and travel times: Save transit riders from 19,000 to 45,000 hours per day (or roughly 57 minutes per passenger, per trip) and reduce regional crowding by 15 to 30%.
  • Increase access between jobs and workers: The average San Francisco worker could access up to 47,000 more jobs in 45 minutes by transit, while the average Bay Area worker could access up to 10,000 more jobs in 45 minutes.
  • Increase regional accessibility: Put 138,000 to 156,000 more households and 382,000 to 404,000 more jobs within walking distance of transit.
  • Support housing affordability: 41,000 to 50,000 new housing units would be in walking distance of rail rapid transit.
  • Reduce localized air pollution and single-occupancy vehicle travel: reduce vehicle miles traveled in San Francisco by 47% corresponding to greenhouse gas emissions reductions of 23,000 to over 35,000 tons per year.
  • Deliver disproportionate benefits to residents of Equity Priority Communities (EPCs): For example, access to jobs within 45 minutes on transit for the average resident of an EPC would increase 60% more than the average of all San Francisco residents (76,000 jobs vs 47,000 jobs).

4.3.1 Ridership

The Geary/19th Ave Subway drives significant ridership increases and is anticipated to deliver a well-used service. A San Francisco-only alignment, without through-running to regional destinations, would serve up to 182,000 daily riders, of which up to 71,000 are net new trips. Decisions about routing within San Francisco such as where to terminate downtown and where to transition south from Geary to 19th Avenue have minimal impact on overall ridership. A regionally connected service could further increase ridership (Table 4-1):

  • Through-running to the south on the existing BART alignment in San Mateo County adds approximately 8,000 (+5%) more users to the project per day as compared to a San Francisco only subway; these riders are shifted largely from existing transit, resulting in minimal impact to the total amount of net new transit trips relative to a San Francisco only subway.
  • Through-running to the East Bay adds approximately 76,000 (using regional rail alignments in the East Bay) or 131,000 (using existing BART alignments in the East Bay) additional daily riders over a San Francisco only subway (a 42% and 74% increase respectively), of which 16,000 and 34,000 respectively are new transit trips.
  • Through-running to San Mateo County and the East Bay (both using existing BART alignments outside of San Francisco) would add approximately 137,000 riders to the Geary/19th Ave Subway, of which up to 35,000 are new transit trips.

This analysis suggests that a stand-alone San Francisco only Geary/19th Ave Subway would transform how people move within the city and region. The inclusion of connections to East Bay has the most significant impact on project performance and could nearly double ridership compared to a San Francisco only subway.

Table 4-1. Project Boardings and Net Transit Trips

San Francisco Only

San Francisco + South Through Running via BART

San Francisco with Through Running to East Bay

San Francisco with Through Running to South and East Bay via BART

Total Boardings on Project

162,000 to 182,000

182,000 to 186,000

258,000 to 309,000

310,000 to 314,000

Net New Transit Trips to/from/within SF

62,000 to 71,000

68,000 to 71,000

86,000 to 104,000

104,000 to 106,000

% Change in SF Transit Ridership

5% to 6%

6%

7% to 9%

9%

Net New Transit Boardings in Region

117,000 to 135,000

128,000 to 135,000

168,000 to 190,000

176,000 to 182,000

% Change in Regional Transit Ridership

4% to 5%

5%

6% to 7%

6%

% Change in Equity Priority Ridership

5%

5%

7%

7%

4.3.2 Travel Times & Rider Experience

The Geary/19th Ave Subway could offer substantial reductions in travel time for Bay Area passengers, saving transit riders from 19,000 to 45,000 hours per day and reduce crowding experienced by transit users by 1532%.

A San Francisco-only Geary/19th Ave Subway can reduce travel time by up to 20,000 hours per day across all travelers who make use of it. For example, transit trips to/from Western SF neighborhoods see significant travel time reductions:

  • SF State and Geary/Fillmore: Up to 17 min (30%) faster
  • Inner Sunset and Stonestown: Up to 10 min (16%) faster
  • Sunset and SFO: Up to 28 min (31%) faster

Design choices on the alignment, such as where to turn between 19th and Geary and the downtown alignment have minimal impact on travel time benefits and crowding relief.

However, providing through-running service to the East Bay offers the most significant benefit to travelers:

  • Connecting to the East Bay using existing BART alignments in the East Bay could save 33,000 hours a day (increase of up to 14,000 hours in time saved relative to a San Francisco only subway, a more than 70% increase in time savings), while also reducing the distance traveled that riders spend on crowded vehicles by up to 28%.
  • Connecting to the East Bay using regional rail alignments will offer only marginal improvements to travel time savings (+3,000 hours saved or 16% compared to San Francisco only) but would lead to an approximately 34% decrease in crowding.
  • Connecting to both the south and the east bay offers a major improvement in performance with up to 45,000 hours saved per year (+26,000 hours saved or 141% compared to the San Francisco only alignment) and would lead to an up to 32% reduction in crowding.

Because of the growth in transit ridership noted above, and the reduction in Vehicle Miles Traveled (VMT) discussed in Section 4.3.4, a Geary/19th Ave Subway also has the potential to deliver benefits for people driving, though these effects are relatively small. The Study found modest travel time benefits and some reductions in vehicle delay during peak periods. For trips by car within San Francisco during peak periods, travel times may decrease by up to one minute per trip.

4.3.3 Accessibility

Accessibility to Jobs

The Geary/19th Ave Subway would improve transit job accessibility for San Francisco and Bay Area residents the average San Francisco resident could access up to 47,000 more jobs in 45 minutes by transit, while the average Bay Area resident could access up to 10,000 more jobs in 45 minutes. Equity Priority Communities (EPCs) see a more significant gain access to 76,000 more jobs for the average EPC resident in San Francisco (60% more than the average San Francisco resident) and 18,000 more jobs for the Average Bay Area EPC resident (80% more than the average Bay Area resident). With through-running to the East Bay, residents of EPCs in San Francisco would see a further 10% increase in jobs access.

An East Bay connection using BART alignments allows for up to 59,000 more jobs within 45 minutes for priority San Francisco workers, while a connection using regional rail alignments could improve accessibility to 76,000 jobs within 45 minutes (Table 4-2).

Table 4-2. Accessibility to Jobs by Transit

San Francisco Only

San Francisco + South Through Running via BART

San Francisco with Through Running to East Bay

San Francisco with Through Running to South and East Bay via BART

45 min SF transit job access

603,000 to 700,000

690,000 to 700,000

700,000

700,000

Change from No Project

42,000 to 45,000

41,000 to 44,000

44,000 to 47,000

44,000 to 47,000

45 min SF transit job access, EPC

770,000 to 780,000

770,000 to 780,000

770,000 to 780,000

770,000 to 790,000

Change from No Project

57,000 to 72,000

57,000 to 72,000

59,000 to 76,000

59,000 to 76,000

45 min Bay Area transit job access

160,000

160,000

160,000 to 170,000

160,000

Change from No Project

7,000 to 8,000

7,000 to 8,000

8,000 to 14,000

9,000 to 10,000

45 min Bay Area transit job access, EPC

280,000

280,000

280,000

280,000

Change from No Project

14,000 to 18,000

13,000 to 16,000

18,000 to 24,000

16,000 to 18,000

Connectivity Between Major Economic and Educational Centers

The Geary/19th Ave Subway would result in significantly faster travel times and greater connectivity between relevant economic centers.

The Geary/19th Ave Subway would introduce high-capacity transit to areas of western San Francisco along 19th Avenue that are currently not well connected to the regional transit network and improve existing service along the congested and crowded Geary Blvd. Neighborhoods such as the Richmond, Sunset, and Outer Sunset see large reductions in time to destinations on the eastern side of the city and, with regional connectivity, the East Bay.

Major trip generators such as university campuses, shopping centers, and San Francisco International Airport (SFO) also benefit from steep reductions in travel time, in particular for East Bay destinations. For example, for the regional rail alignment options, trips to and from Emeryville would see an average reduction in travel time of roughly 30 minutes for destinations across San Francisco, roughly 35% percent faster (Table 4-3)

Table 4-3. Travel Time Savings (in minutes)

Between

San Francisco Only

San Francisco + South Through Running via BART

San Francisco with Through Running to East Bay

San Francisco with Through Running to South and East Bay via BART

UCSF Parnassus

Salesforce Transit Center

Up to 20.4

Up to 20.4

Up to 2.3

Up to 5.9

SFSU

Japantown

12.2 to 17.6

12.2 to 17.6

12.2 to 12.2

Up to 17.6

Stonestown

Geary/Masonic

9.3 to 11.8

9.3 to 11.8

9.3 to 9.3

Up to 11.8

SF State

Downtown Oakland

15.7 to 18.9

15.7 to 18.9

16.4 to 22.0

16.4

The Sunset

Redwood City

15.9 to 19.1

15.9 to 19.5

15.9 to 19.5

24.4

Golden Gate Park

Emeryville

2.9 to 3.1

2.9 to 3.2

3.2 to 28.3

3.2

SFO

Sunset

17.3

17.3

17.3

26.8

Design choices within San Francisco will also have an impact on travel time savings and what trips benefit most from them including the choice of route through downtown and how the subway connects between Geary Blvd and 19th Ave.

4.3.4 Regional Climate Policies and Air Quality

Greenhouse Gas Emission Reduction

A Geary/19th Ave Subway could reduce greenhouse gas (GHG) emissions by 23,000 to over 35,000 tons per year, depending on the degree of electric vehicle uptake for private vehicle use.

Figure 4-1 presents the range of GHG reductions expected for each reference conceptual alignment. This range includes both design variations as well as adjustments for different levels of ZEV adoption, including for baseline, low EV, and high EV scenarios.

Preliminary modeling suggests only minor changes in GHG emissions between scenarios. In general, through running service to the East Bay offers higher ridership, and therefore greater Vehicle Miles Traveled (VMT) and GHG reductions. However, the most significant contributions to GHG reductions occur in San Francisco.

Figure 4-1. Change in Greenhouse Gas Emissions by Scenario
A chart showing the varying levels of change in greenhouse gas emissions by scenario.

Download chart data (CSV)

Vehicle Miles Traveled (VMT) Reduction

A Geary/19th Ave Subway could reduce vehicle miles traveled in San Francisco by approximately 400,000 miles per day, or a 4% reduction, versus a future without the project. Regionally connected scenarios could see even further reduction, up to an additional 50,000 miles per day within San Francisco, for a total of 450,000 miles per day.

Some areas of San Francisco demonstrate greater rates of behavior change. In terms of VMT per capita, the biggest shifts occur in neighborhoods with already low to moderate rates of vehicle dependency, though Southwestern San Francisco, which has the highest rates of VMT per capita in the city today, sees a reduction at or slightly above the citywide percentage in the best performing scenarios:

  • Richmond: 511 percent reduction in VMT/capita
  • Western Addition: 710 percent reduction in VMT/capita
  • Inner Sunset neighborhoods: 811 percent reduction in VMT/capita
  • Southwestern San Francisco: 25 percent reduction in VMT/capita

Regional connectivity options offer the biggest shifts in VMT per capita across all neighborhoods.

Air Quality Improvements

A Geary/19th Ave Subway would support local, regional, and state goals for air quality. The study converted VMT reductions into local air pollutant equivalents on an annual basis using the California Air Resource Board’s guidelines. These pollutants include:

  • NOx (Nitrogen Oxides): NO and NO2 contribute to ground-level ozone and smog, trigger respiratory issues like asthma, and can form acid rain that harms ecosystems and infrastructure.
  • SOx (Sulfur Oxides): Mainly SO2, these gases irritate the lungs, worsen respiratory diseases, and react in the atmosphere to form acid rain and fine particulate matter, damaging crops, forests, and buildings.
  • PM2.5 (Particulate Matter ≤2.5 microns): These microscopic particles lodge deep in the lungs and enter the bloodstream, increasing the risk of heart and lung diseases, cancer, and early death.

Pollution varies as a function of VMT reduction alignments with greater VMT reduction would have stronger pollution reduction. Accordingly, project scenarios that include through-running to the East Bay have the most significant impact on pollution (Table 4-4).

Table 4-4. Change in Pollutant Amounts

San Francisco Only

San Francisco + South Through Running via BART

San Francisco with Through Running to East Bay

San Francisco with Through Running to South and East Bay via BART

NOx (kg)

−2,440kg to −2,620 kg

−2,500 kg

−2,800kg to −2,630 kg

−2,790 kg

SOx (kg)

−270kg to −290 kg

−280 kg

−320kg to −300 kg

−310 kg

PM2.5 (kg)

−640kg to −680 kg

−650 kg

−730kg to −690 kg

−730 kg

Other Key Building Blocks

The Geary/19th Ave Subway is one of five major transit expansion projects identified in San Francisco’s Transit Strategy (2021). The Transit Strategy is a key blueprint within the overarching policy framework set by the long-range San Francisco Transportation Plan (SFTP), most recently adopted in 2022.

The SFTP calls for an integrated approach to developing San Francisco’s transportation system, including through investment in the transportation system, development of new revenues, and advancement of demand management strategies including pricing. Within this framework, the Geary/19th Ave Subway is an important component of an integrated strategy to achieve San Francisco’s transportation goals and meet state and regional policy requirements. In turn, the benefits of the Geary/19th Ave Subway will be amplified through supportive policies, some of which would be anticipated to play a role in the project's funding strategy. Put simply, the viability and benefits of the project are linked with the continued progression of initiatives to manage San Francisco's transportation system and to develop new sources of funding.

Consistent with the SFTP’s policy framework, this section describes a set of other key building blocks for the Geary/19th Ave Subway. These factors were informed by an examination of peer projects in San Francisco and California, as well as other recently planned and delivered subway projects in North America and beyond. Particularly important, as discussed in this chapter, are the set of potential value capture and pricing strategies which would support project benefits and in some cases could yield revenue. While this study does not recommend the specific approach to advancing these building blocks, it does conclude that they should advance as part of or in parallel to the next phase of the project. The decision to advance the subway to future stages of development should consider these opportunities to develop and attract innovative approaches to project development, funding, and delivery.

5.1 Project Cost and Funding

An urban rail transit project such as the Geary/19th Ave Subway is a large, complex public investment. Existing local, regional, state, and federal funding sources are not sufficient to fully fund the project, which has an initial cost estimate range of approximately $20B$30B in 2026 dollars, as discussed in Chapter 4. The project has the potential to drive significant value creation in multiple areas (such as travel time, land value, economic development, and environmental quality). The study team identified potential mechanisms to return a part of this value to the project, helping to support its funding plan. It is important to begin exploring these mechanisms in parallel with early planning, to inform further development of the funding strategy and advancement of specific funding sources during future phases of work.

5.1.1 Funding Strategy: Key Considerations

This study developed an initial set of key considerations to inform the development of the project’s funding strategy:

  • All levels of government will be indispensable to funding the project A transit project with the scale of investment and benefits of the Geary/19th Ave Subway will require and merit co-investment from the local, regional, state, and federal levels.
  • Regional and state investment in the project should reflect its broad benefits and critical role in the Bay Area and statewide transportation systems While primarily located within San Francisco, the Geary/19th Ave Subway will deliver wide benefits and will serve riders from across the Bay Area and the broader Northern California mega-region. Regional and state funding will be critical components of the project’s funding plan.
  • Self-help by San Francisco will be foundational including through early implementation of project-specific funding sources Local funding will be a critical foundation of the project’s funding plan, demonstrating local commitment to federal and state funders and helping to accelerate project development and delivery. For example, the availability of project-specific funding would help to progress the project through more advanced stages of project development, such as environmental review and preliminary design, increasing the project’s readiness for discretionary grants.
  • The funding strategy should leverage the significant value created by the project Existing funding sources are not sufficient to deliver the project, and the funding toolkit will require the concerted development of new funding sources. In particular, there is an opportunity to harness the benefits of the project through a range of potential value capture funding mechanisms, as further discussed below.
  • Opportunities for private sector partnerships should be actively developed and pursued, including to manage risk, undertake project delivery, and support project financing The private sector will be a key partner in delivering the project, including to complete the project’s design and to undertake construction. In addition, there are also potential project delivery models under which the private sector could support project financing, such as public-private partnership delivery methods. Future stages of project development will include preparation of the project delivery and procurement strategy, which will consider these options and the potential opportunities for the project.
  • Development of the funding strategy must be a central focus at each stage of project planning and development Building the project’s funding plan will take time and future phases of work should address both the full funding plan as well as intermediate funding needs for successive phases of project development such as preliminary design and environmental review.

5.1.2 Value Capture Mechanisms

San Francisco, the Bay Area, and the State of California have a history of developing innovative funding approaches in order to make generational investments in our transportation system. Drawing a nexus between the value the Geary/19th Ave Subway would create and potential sources of funding is an initial step in considering these new funding options. For example, transportation projects that significantly increase accessibility and reduce travel times can contribute to uplift in land values. Table 5-1 below shows some potential value capture strategies for consideration as the project’s funding plan is developed.

Table 5-1. Potential Value Capture Mechanisms

Type of Value Generated by Project

Potential Value Capture Mechanisms

Land Use and Land Value

  • Corridor/Area Tax Increment
  • Corridor/Area Community Facilities District
  • Benefit Districts
  • Joint Development
  • Development Impact Fee
  • Infrastructure Finance District

Local and Regional Economic Growth

  • Citywide Community Facilities District
  • Sales Tax

Mobility Improvements

  • Tolling
  • Managed Lanes
  • Road User Charges

Climate and Environment

  • Greenhouse Gas Offsets or Credits
  • Other developing strategies

Value Capture in San Francisco

Multiple projects in San Francisco have benefited from value capture to contribute to their funding plan and delivery. Recent examples include:

Salesforce Transit Center and its surrounding buildings, seen from above and from the south.
Salesforce Transit Center:

The Salesforce Transit Center is San Francisco’s regional transit hub. The Transbay Joint Powers Authority (TJPA) utilized multiple techniques to contribute about half of the funding plan for the Transit Center itself. Specifically, the project funding plan included in part:

  • Land Sales: Proceeds from the sale of nearby and formerly state-owned parcels to private developers to be used for project costs.
  • Tax Increment Financing: The use of net tax increment attributable to those properties, once sold to and developed by private developers, to secure long-term financing for the project.
  • A Community Facilities District (CFD): The use of special taxes within a Mello-Roos CFD to secure financing for the project.
Rendering of Treasure Island after it's been fully built out, showing housing and office buildings. There is a ferry pulling up to a dock in the foreground.
Treasure Island:

By 2042, the Treasure Island neighborhood will grow by up to 8,000 homes — many offered at below-market rates — housing more than 20,000 new residents. The Treasure Island Mobility Management Agency is developing a comprehensive transportation framework that will meet the current and future needs of residents, workers and visitors to ensure a vibrant community. Among other sources, the full funding plan for the transportation framework anticipates making use of:

  • Tolling & Congestion Pricing: Revenue from tolls paid by vehicles accessing the island will be used to support expanded transit operations, subsidized transit passes, and equity programs.
  • A Public-Private Partnership: The development agreement for Treasure Island includes contributions from the developer towards infrastructure, including roads, parks, utilities, transit, and other ongoing public benefits.

Subsequent phases of work should include the development of an indicative funding plan for the project, reflecting the ranges of potential funding from existing and new sources. This plan should include initial revenue range analyses for a range of potential new sources, developed to an order-of-magnitude level, with a focus on the sources that could harness the value created by the project, as described above. Development of this indicative funding plan will also require coordination with other related efforts, such as pricing studies, travel demand management initiatives, and regional and statewide rail planning and development efforts. Future phases of study will also seek and include input on potential funding strategies from members of the public and policy-makers.

5.2 Engagement & Outreach

In addition to technical work, engagement with residents, businesses, institutions, and community stakeholders will continue to be essential to advancing project development for the Geary/19th Ave Subway. This study included public outreach activities, to identify key interests and potential concerns of community members. Future phases will also include public engagement efforts, as specifics about the subway and its design, construction, and operation come into better focus. As discussed in Chapter 4, significant project decisions, while informed by technical analysis, will be guided by input from stakeholders and direction from elected officials in particular, the project’s routing and station locations along the corridor.

For this phase of work, the study team conducted two rounds of outreach using online town halls, focused on surfacing community interest and questions and sharing the results of the preliminary analysis. The study team also presented directly to interested neighborhood groups and other community based organizations, and hosted an online survey which received over 2,400 responses. The feedback at both in-person and online events, along with the survey, was consistent: respondents broadly understood the need for a Geary/19th Ave Subway, and were interested in exploring ways to deliver the project more quickly and at lower cost. Some community members raised questions about potential construction methods and disruptions related to construction to both residents and businesses. These questions will be addressed in more detail in subsequent project stages, as detailed in Chapter 6.

5.3 Anti-Displacement & Community Stabilization

Potential indirect displacement resulting from new transit investments is both a real and perceived concern for residents and small businesses who live near proposed transportation projects. Depending on local conditions, improved accessibility or services resulting from such investments can drive up land value, increase rents, and potentially displace existing tenants without protection policies in place. Ultimately, the intention of major transit investments is to improve access to opportunities like jobs, education, healthcare, recreation for those along the project corridor and beyond.

While a future Geary/19th Ave Subway project would not be the only force driving displacement pressures in San Francisco, research shows that new transit investments can contribute to market trends that may already be impacting neighborhoods. The subway project would serve as a catalyzing opportunity to put into place additional anti-displacement tools and to support existing residents in benefiting from the improved access provided by the project in the future. Developing a proactive approach to address indirect displacement early is critical. In practice, this means building a deep understanding of neighborhood conditions including to identify opportunities to tailor and apply specific anti-displacement strategies within the neighborhoods along the project corridor. This work will also require community engagement and outreach, to inform and guide anti-displacement efforts over time.

At the time of writing, San Francisco currently employs almost 30 residential anti-displacement tools, and over 20 commercial anti-displacement strategies. These strategies are an integral part of San Francisco’s efforts to address and maintain affordability for existing residents and businesses. As part of this study, the San Francisco Planning Department compiled an analysis of these strategies, as well as other that have been used in peer projects, and identified which could be advanced by the project itself and those that would be better deployed on a citywide basis in parallel with development of a Geary/19th Ave Subway. The analysis and report is available as Geary/19th Ave Anti-Displacement Strategy Technical Memorandum.

Example Anti-Displacement Tools in San Francisco

Residential anti-displacement policies broadly fall into three categories: protection, preservation, and production. Existing San Francisco policies and programs are among those that research has shown to be effective in addressing potential displacement, including but not limited to:

  • Inclusionary zoning
  • Anti-tenant harassment laws
  • Rent control
  • Just-cause eviction
  • Tenant options to purchase
  • Community land trusts and cooperatives

San Francisco’s commercial anti-displacement policies also include a number of policies to assist existing and legacy businesses to remain in place. Some examples of these policies include:

  • Legacy business preservation programs
  • Technical assistance and counseling
  • Formula business restrictions
  • Construction disruption assistance
  • Community benefit agreements

A full list of strategies, and example programs within San Francisco, can be found in Geary/19th Ave Anti-Displacement Strategy Technical Memorandum.

5.4 Project Development and Prioritization

The Geary/19th Ave Subway is one of five major rail and transit enhancements identified in the ConnectSF Transit Strategy (2021) and the 2050 San Francisco Transportation Plan (2022), San Francisco’s long-range planning document for the transportation system. Each project will require substantial funding to advance from concept to final construction and delivery. While these plans laid out the initial concepts of each project (see call-out box), they did not prioritize the order in which each should advance or be implemented.Though these plans did not conduct an analysis to prioritize amongst the long-range transit expansions included, each identified The Portal as a clear near term priority, given its advanced stage of project development and long-standing local and regional plan status. The Portal has been identified as a regional transit expansion priority since 1988 (MTC Resolution 1876), has progressed in the FTA funding process, and is already under procurement. Though the responsible agencies have the capacity to advance initial planning efforts for multiple projects in parallel, in the future San Francisco and its partners will need to make a determination on the sequence in which projects will advance, as subsequent phases of project development and design will require larger commitments of resources.

San Francisco’s Five Planned Transformative Rail Projects

ConnectSF and the 2022 San Francisco Transportation Plan identified five major rail and transit projects with the potential to deliver significant benefits to San Francisco and the region. Each project is advancing independently on its own timeline. The five projects are:

  • The Portal and Pennsylvania Rail Extension, to bring Caltrain and future high speed rail service underground to the Salesforce Transit Center.
  • The Geary/19th Ave Subway to serve the city’s most crowded bus corridor, connecting some of our busiest neighborhoods to downtown and regional destinations
  • A Central Subway Extension to Fisherman’s Wharf to bring rail service to some of San Francisco’s most populous neighborhoods and relieve crowding on several busy Muni routes.
  • A new Bayview Caltrain Station to restore regional rail access to a community that was previously served, and provide fast access to opportunities downtown and on the Peninsula.
  • A new transbay rail crossing to allow regional rail service to grow beyond the capacity of the existing BART tube, increasing access for residents throughout the Bay Area and the Northern California megaregion. This project is being advanced through the Link21 program.

Project prioritization is anticipated to begin with the preparation of the next major update to the San Francisco Transportation Plan (SFTP), SFTP 2060, which is planned to kick off in 2027. This plan will use updated information about each project’s performance, as well as other effectiveness and readiness criteria, to make recommendations regarding how and on what timeline San Francisco’s full vision of long-range transit and rail expansion should advance. Through the SFTP process, projects will be evaluated based on their impact with respect to the SFTP goals: equity, economic vitality, environmental sustainability, safety & livability, and accountability & engagement.

Major projects also need to be prioritized on a regional scale to be competitive for outside funding. The Metropolitan Transportation Commission (MTC) prepares Plan Bay Area, the regional transportation plan for the nine-county Bay Area, which will evaluate major projects from San Francisco and across the region. Eventually, project advancement for the Geary/19th Ave Subway will also require securing an endorsement for federal or state funds under the MTC’s Major Advancement Policy (MAP).

5.4.1 Federal Project Evaluation

Based on the project performance profile described in Chapter 4, we expect the Geary/19th Ave Subway would be competitive under existing federal criteria for the Federal Transit Administration’s Capital Investment Grant Program. This program evaluates projects under two broad areas:

  • Project Justification includes consideration of supportive land use, cost per rider, mobility improvements, congestion reduction, environmental benefits, and economic development.
  • Local Financial Commitment assessment of the sponsor’s financial capacity to construct and operate the project, including local funding commitments and the project’s financial plan.

While San Francisco’s existing Prop L transportation sales tax provides limited funding for planning and project development of transit projects, additional local, regional, and state funding will need to be identified to demonstrate local financial commitment and support the full build-out of the subway.

5.5 Planning to Address Construction Phase Impacts

As a subway, the bulk construction activity for the project will occur underground, helping to reduce disruptions to communities during construction. At the same time, construction at street level will be necessary, including for tunnel access, stations, and ventilation, among other elements. Input and concerns regarding the effective management of construction were also a consistent theme raised by the public during the study’s town halls and presentations with community organizations.

San Francisco has learned meaningful lessons from recent and current subway projects, including the Central Subway and The Portal, as well as other corridor-focused projects such as Van Ness BRT and the Taraval Corridor Improvement Project. For the Geary/19th Ave Subway, future stages of project planning will require careful design and community engagement, to develop construction-phase strategies that reduce and mitigate impacts to neighborhoods. The project should also consider the application of best practices for urban subway construction along busy corridors for example, approaches that allow the construction of new stations below roadway decking to preserve the flow of street users, as has been used recently on LA Metro’s Purple Line (D) Extension Project.

Conclusions & Next Steps

This chapter summarizes the conclusions of this study, demonstrates the case for the Geary/19th Ave Subway, and identifies potential next steps.

6.1 Conclusions

This study has found that a grade separated, high capacity rapid transit investment is both needed and viable in the Geary Boulevard and 19th Avenue corridors in Western San Francisco. As future phases of the project are completed, significant project decisions will need to be considered related to regional integration, routing and station location, technology, and funding, in increasing levels of detail. Future phases will also more deeply explore the trade-offs among these decisions, informed by more robust engineering, planning, and cost estimation than was completed in this initial phase of work.

In summary, this study has found that:

  • The case for the Geary/19th Ave Subway is promising: The Geary/19th Ave Subway is an integral part of the future San Francisco, Bay Area, and statewide rail system, and San Francisco should continue to advance planning and project development. The project will create value in time savings for travelers, accessibility and value of land, and economic activity and productivity; leveraging this value will be key to the project’s viability and success.
  • Regional connectivity expands and broadens benefits: The Geary/19th Ave Subway performs well as a San Francisco-only investment, but performs much better as an integrated part of the region’s rail network. By enabling through-running of trains beyond San Francisco, project benefits would also accrue to a wider range of Bay Area residents, workers, visitors, and travelers.
  • Multiple design options can provide improvements: Choices about how to route the project at both ends of the alignment and for the connection between Geary Blvd and 19th Ave should be informed by additional technical work and robust engagement with stakeholders. While project performance of the various options for these segments of the project is similar, the profile of project benefits may vary depending on the final routing and station location decisions made in future phases.
  • The Geary/19th Ave Subway delivers travel time savings, environmental improvements, and equity benefits: In future years, the project drives improvements in many key metrics related to travel time, environmental quality, and equity as compared to a future where the project is not built.
  • Project development and delivery will require significant new funding sources: While the project is expected to perform well under traditional federal and state funding criteria, major transit investments such as the Geary/19th Ave Subway must secure support from all levels, including the development of new, project-specific funding sources.
  • A Geary/19th Ave Subway will drive value creation: Investing in the Geary/19th Ave Subway will create value in terms of land use, economic activity, mobility improvements and time savings, and reduced climate impacts. Capturing a share of this value will be a critical element of the project’s funding plan, and will help to secure other regional and state funds.

6.2 Next Steps

6.2.1 Project Development and Delivery Stages

The Geary/19th Ave Subway and Regional Connections Study is the initial step of a multi-year process by which a major transit capital investment is planned, environmentally cleared, designed, constructed, and eventually opened for passenger service. Projects usually proceed through multiple stages of development, with the conclusion of each supporting decision-making regarding the project’s readiness and worthiness to advance to subsequent stages. These broad phases of project development and implementation are summarized in Table 6-1 below:

Table 6-1. Typical Project Development and Delivery Stages

Project Stage

Key Decisions

Level of Project Definition

Typical Studies / Activities Conducted (Federal Context)

Project Initiation and Feasibility Assessment

Confirm the corridor and whether a major transit investment is warranted.

Conceptual: Problem defined; corridor and travel market understood.

Corridor planning, strategic case including impacts of not taking action, travel-demand and network analysis, policy consistency review, preliminary funding concepts.

Stage Objective: Define the problem and needs and confirm that a subway is an effective and viable response.

Federal: Metropolitan Planning Process / FTA Pre-Project Development.

Alternatives Analysis

Develop a project Purpose and Need; identify and compare a reasonable range of project alternatives.

Preliminary: Conceptual alignments, stations, and technology families defined.

Conceptual engineering (~5 %), order-of-magnitude costs, ridership and benefits analysis, risk and constructability screening, stakeholder engagement, funding strategy development.

Stage Objective: Identify and compare concept(s) which respond to the Purpose and Need.

Federal: Alternatives Analysis preceding FTA Project Development phase.

Preliminary Engineering & Environmental Review

Prepare state and federal environmental documentation; advance preliminary engineering; confirm the preferred alternative; obtain environmental clearance.

Defined: Horizontal and vertical alignment, planned station locations, and service concept established.

Preparation of CEQA Environmental Impact Report (EIR) and NEPA Environmental Assessment (EA) or Environmental Impact Statement (EIS); preliminary engineering (~15%); environmental technical studies (noise, vibration, traffic, air quality, equity); cost and risk refinement; preliminary funding and delivery plan.

Stage Objective: Secure environmental clearance, with impacts addressed and project engineered to a feasible design.

Federal: FTA Project Development phase (CIG program).

Advanced Design & Procurement Preparation

Select delivery/procurement model; advance design to level needed for delivery model; secure capital funding commitments; confirm agency roles and governance for delivery phase.

Detailed: 30% to 100% design; right-of-way and utilities defined; construction packages prepared.

Plans, Specifications & Estimates (PS&E); right-of-way acquisition and certification; utility relocation design; constructability and safety reviews; procurement preparation; readiness for FTA Full Funding Grant Agreement (FFGA); preparation of inter-agency agreements and other third-party agreements. Potential for early works, to de-risk major contract packages.

Stage Objective: Readiness for procurement and delivery.

Federal: FTA Engineering phase.

Procurement and Construction

Procure and award major contracts and deliver civil, systems, and station works.

Fixed: Design complete and cost baseline established.

Procurement, contract administration, construction management, quality assurance, mitigation compliance, testing and commissioning.

Stage Objective: Turn the approved design into a functioning transit asset.

Federal: FTA Oversight during construction under CIG.

Testing, Commissioning, and Operational Readiness

Commission the system and achieve full readiness for revenue service, and transition to long-term operation.

As-built: Final configuration validated and transferred to operator.

Safety certification, staff training, startup testing, service monitoring, and performance reporting. State and federal safety/regulatory approvals, as appropriate/required.

Stage Objective: Demonstrate that the subway operates safely, reliably, and sustainably.

Federal: FTA Grant Compliance and Asset Management reporting.

6.2.2 Timeline

Because major transit capital projects are complex undertakings involving many stakeholders, varied interests, and multiple approvals, it usually takes at least 15 to 20 years to progress from project initiation to revenue service. For a project of the scale and characteristics of the Geary/19th Ave Subway, approximate minimum timelines (subject to funding) for each major stage of project development are as follows:

  • Project Initiation and Feasibility Assessment: approximately 23 years
  • Alternatives Analysis: approximately 23 years
  • Preliminary Engineering and Environmental Review: approximately 24 years
  • Advanced Design and Procurement Preparation: approximately 24 years
  • Construction: approximately 58 years, depending on delivery approach and phasing (if any)
  • Testing, Commissioning, and Operational Readiness: approximately 1824 months

Peer projects in California have typically spent a total of approximately 58 years in the Planning, Alternatives Analysis, and Environmental stages, followed by approximately 710 years for construction and commissioning. Projects moving more quickly through these steps typically demonstrate robust local and regional financial commitment, including through voter-approved funding measures, that enable project sponsors to secure necessary approvals and commitment of state and federal funding. Recently, there have also been efforts to streamline the environmental phase for certain transit projects; such opportunities could be explored in the future for the project.

In order to successfully advance a major capital rapid transit project such as the Geary/19th Ave Subway, there are three broad areas of focus that support the ability for progress over time:

  • Project Performance Projects with strong benefits, including in relation to estimated costs, will perform better in project prioritization processes, as discussed in Chapter 5 of this report. The development and implementation of supportive policies such as land use and Travel Demand Management (TDM) provide opportunities to increase benefits and strengthen project performance.
  • Public and Policy Support Demonstrated community support strengthens a project’s ability to move forward, as does strong support and championing of the project from a policy perspective at both the local and regional levels.
  • Local and Regional Financial Commitment Local and regional funding is the foundation of a project’s funding plan, and typically provides some or all of the budget for pre-construction stages of work.

Progressing to each stage of project development also requires the availability and commitment of funding to undertake the next stage of work. At present, limited project-specific funding for the project has been identified, and the immediate next phase of work (discussed below) is contemplated to include work to further explore promising sources of funding, develop an initial indicative funding plan, and engage with the public on key funding opportunities and tradeoffs.

6.2.3 Immediate Next Phase of Project Development

The completion of Concept Development and Alternatives Analyses studies for the Geary/19th Avenue Subway are estimated to require approximately $10 million to $15 million, depending on the number of alternatives explored and level of engineering design required. The study has identified an initial set of prioritized Alternatives Analysis tasks that could be advanced with available funding approximately $1.5 million in programmed half-cent sales tax funds, up to $3 million if the project is successful in securing competitive regional funding in the near term. This work would also engage with community stakeholders and develop technical understanding to help narrow the universe of options under consideration.

The following technical and engagement task areas have been identified for potential incorporation into the immediate next phase of project development:

  • Concept development (Local/Regional integration) additional early concept-level design development of project interfaces with the regional transit network, including at the Downtown and southern ends of the project alignment.
  • Technology evaluation assessment and comparison of the rail technology options for the project, with consideration of key tradeoffs for cost, integration, phasing, facilities, and other issues.
  • Station and facility sizing and potential locations early concept-level definition of footprints for potential station locations and for needed operations and maintenance facility(ies).
  • Capital cost refinement development of updated planning-level cost estimates, based on additional early concept-level design development and reference projects.
  • Funding strategy preparation of an indicative funding plan and assessment supported by early development of potential project-specific funding mechanisms.
  • Engagement with the public, stakeholders, and partners community outreach and collaboration with key local, regional, and state agencies.

The inclusion of specific tasks within a next phase of work will be subject to available funding, including external grant funding from regional and state sources. An overall aim of the immediate next phase would be to undertake prioritized work that is supportive of subsequent completion of the full Alternatives Analysis stage, including preparation for the future Environmental Review stage.

Acknowledgments

The preparation of this report has been financed in part by grants from the Federal Highway Administration, U.S. Department of Transportation. The contents of this report do not necessarily reflect the official views or policy of the U.S. Department of Transportation.

This report was funded by the San Francisco County Transportation Authority through a grant of Prop L transportation sales tax funds

Project Team

San Francisco County Transportation Authority

  • Andrew Heidel, Principal Planner
  • Jesse Koehler, Director of Strategy
  • Brittany Chan, Communications Officer

San Francisco Municipal Transportation Agency

  • Kansai Uchida, Planning Manager
  • Liz Brisson, Senior Planning Manager
  • Michael Randolph, Senior Transit Planner

San Francisco Planning Department

  • Joshua Switzky, Deputy Director, Citywide Planning
  • Mathew Snyder, Senior Planner

Steer

  • Patrick Miller, Project Director
  • Kate Bridges, Project Manager
